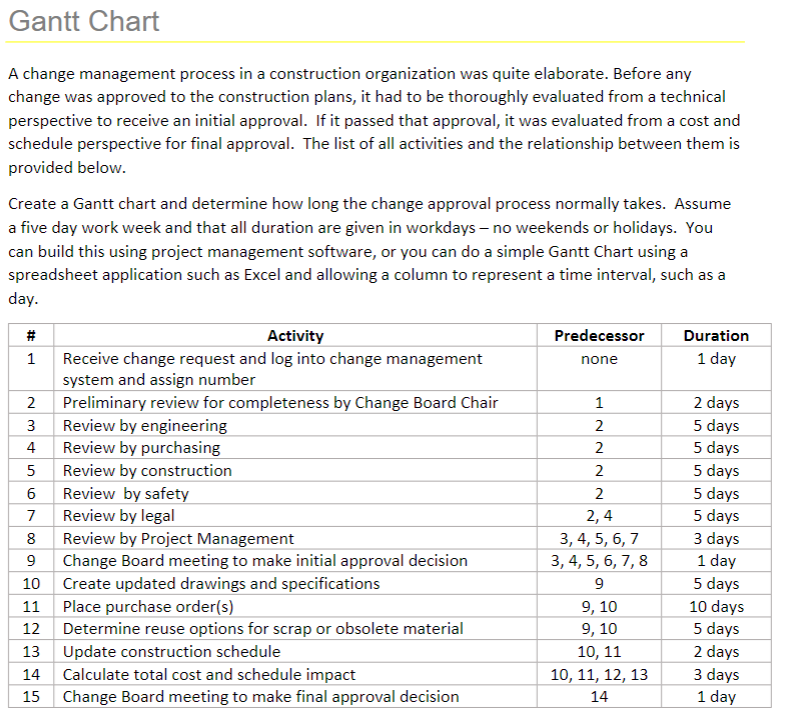

Question: Gantt Chart A change management process in a construction organization was quite elaborate. Before any change was approved to the construction plans, it had to

Gantt Chart
A change management process in a construction organization was quite elaborate. Before any
change was approved to the construction plans, it had to be thoroughly evaluated from a technical
perspective to receive an initial approval. If it passed that approval, it was evaluated from a cost and
schedule perspective for final approval. The list of all activities and the relationship between them is
provided below.
Create a Gantt chart and determine how long the change approval process normally takes. Assume
a five day work week and that all duration are given in workdays no weekends or holidays. You
can build this using project management software, or you can do a simple Gantt Chart using a
spreadsheet application such as Excel and allowing a column to represent a time interval, such as a
day.
# Activity Predecessor Duration
1 Receive change request and log into change management
system and assign number
none 1 day
2 Preliminary review for completeness by Change Board Chair 12 days
3 Review by engineering 25 days
4 Review by purchasing 25 days
5 Review by construction 25 days
6 Review by safety 25 days
7 Review by legal 2,45 days
8 Review by Project Management 3,4,5,6,73 days
9 Change Board meeting to make initial approval decision 3,4,5,6,7,81 day
10 Create updated drawings and specifications 95 days
11 Place purchase order(s)9,1010 days
12 Determine reuse options for scrap or obsolete material 9,105 days
13 Update construction schedule 10,112 days
14 Calculate total cost and schedule impact 10,11,12,133 days
15 Change Board meeting to make final approval decision 141 dayGantt Chart
A change management process in a construction organization was quite elaborate. Before any change was approved to the construction plans, it had to be thoroughly evaluated from a technical perspective to receive an initial approval. If it passed that approval, it was evaluated from a cost and schedule perspective for final approval. The list of all activities and the relationship between them is provided below.
Create a Gantt chart and determine how long the change approval process normally takes. Assume a five day work week and that all duration are given in workdays - no weekends or holidays. You can build this using project management software, or you can do a simple Gantt Chart using a spreadsheet application such as Excel and allowing a column to represent a time interval, such as a day.
\table[[#,Activity,Predecessor,Duration],[1,\table[[Receive change request and log into change management],[system and assign number]],none,1 day],[2,Preliminary review for completeness by Change Board Chair,1,2 days],[3,Review by engineering,2,5 days],[4,Review by purchasing,2,5 days],[5,Review by construction,2,5 days],[6,Review by safety,2,5 days],[7,Review by legal,2,4,5 days],[8,Review by Project Management,3,4,5,6,7,3 days],[9,Change Board meeting to make initial approval decision,3,4,5,6,7,8,1 day],[10,Create updated drawings and specifications,9,5 days],[11,Place purchase order(s),9,10,10 days],[12,Determine reuse options for scrap or obsolete material,9,10,5 days],[13,Update construction schedule,10,11,2 days],[14,Calculate total cost and schedule impact,10,11,12,13,3 days],[15,Change Board meeting to make final approval decision,14,1 day]]
 Gantt Chart A change management process in a construction organization was

Step by Step Solution

There are 3 Steps involved in it

1 Expert Approved Answer
Step: 1 Unlock blur-text-image
Question Has Been Solved by an Expert!

Get step-by-step solutions from verified subject matter experts

Step: 2 Unlock
Step: 3 Unlock

Students Have Also Explored These Related General Management Questions!
