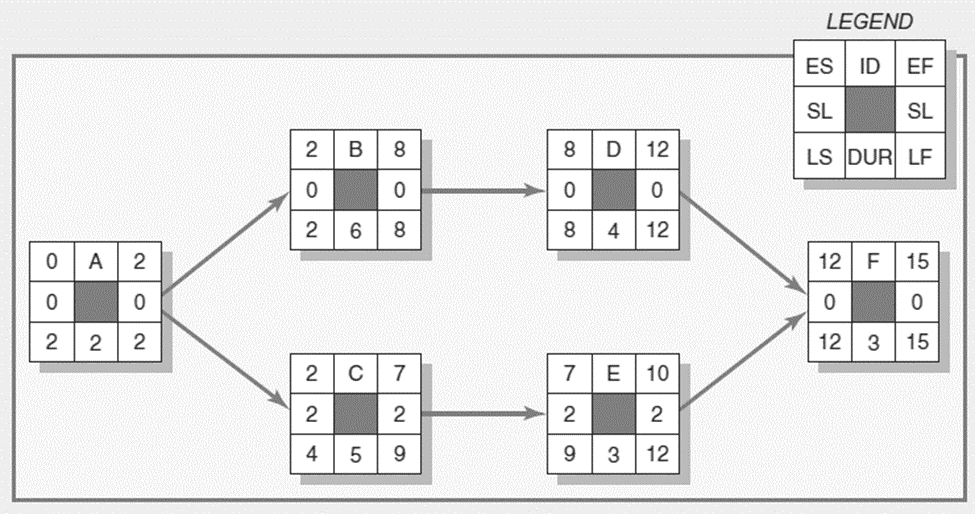

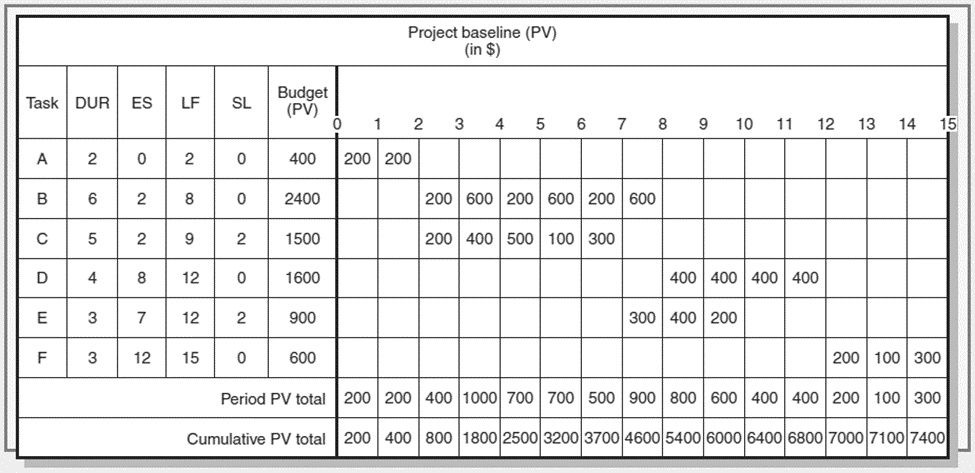

Question: Given the following project network, baseline, and status information, develop status reports for periods 5 and 10 and complete the performance indices table. Calculate the
Given the following project network, baseline, and status information, develop status reports for periods 5 and 10 and complete the performance indices table. Calculate the EACf and the VACf. Based on your data, what is your assessment of the current status of the project? At completion? Then answer the questions.

1.
Based on your data, at the end of Period 5, the PV for Task B is equal to $________.
Group of answer choices
1200
400
1000
300
2.
Based on your data, at the end of Period 5, the CV for Task A is equal to $________.
Group of answer choices
140
-100
100
-140
3.
Based on your data, at the end of Period 5, the SV for Task A is equal to $________.
Group of answer choices
0
-300
300
-100
4.
Based on your data, at the end of Period 5, the cumulative total of CV is equal to $________.
Group of answer choices
-540
60
540
-60
5.
Based on your data, at the end of Period 5, the cumulative total of SV is equal to $________.
Group of answer choices
-240
60
-60
240

End of Period 5 End of Period 10 Performance Indices Summary (round to 2 decimal places)
