Question: Given the following project network, baseline, and status information, develop status reports for periods 2, 4, 6, 8 and and complete the performance indexes table.

Given the following project network, baseline, and status information, develop status reports for periods 2, 4, 6, 8 and and complete the performance indexes table. Calculate the EACf and the VACf.

Given the following project network, baseline,Given the following project network, baseline,Given the following project network, baseline,Given the following project network, baseline,

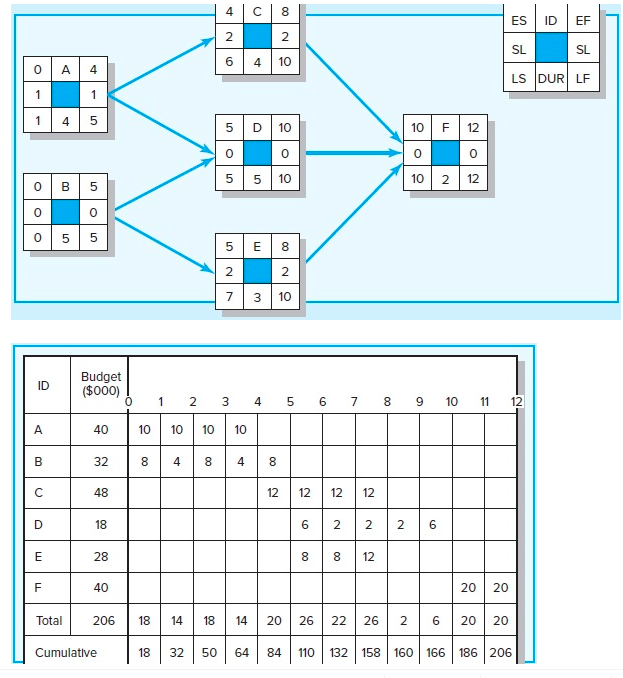

0 A 4 1 1 1 4 5 0 B 5 0 0 5 5 Budget ($000) 40 32 O ID A B D E F Total Cumulative 00 8 1 2 48 18 28 40 206 18 14 st 3 10 10 10 4 8 00 4 8 2 2 6 4 10 5 D 10 0 5 10 E 8 2 3 10 4 5 6 O 5 5 2 7 st 7 8 12 12 12 12 6 8 8 12 20 20 18 14 20 26 22 26 26 20 20 18 32 50 64 84 110 132 158 160 166 186 206 00 4 00 00 10 F 00 LL O ES EF SL SL LS DUR LF 12 0 10 2 12 89 10 11 12 2 6 ID (Do not round intermediate calculations. Enter all answers to 2 decimal precision. Enter PCI-B in percent format (e.g., enter 73.05% if the decimal equivalent is 0.7305.) Status Report: Ending Period 2 Task % Complete EV AC PV CV SV A 75.00 B 55.00 Cumulative Totals Status Report: Ending Period 4 Task % Complete A 100 B 100 Cumulative Totals EV 21.00 12.00 33.00 AC 39.00 21.00 60.00 PV CV SV Status Report: Ending Period 6 Task % Complete A 100 B 100 C 80.00 D 0 E 55.00 Cumulative Totals Status Report: Ending Period 8 Task % Complete A 100 B 100 100 30.00 100 D E Cumulative Totals EV EV AC AC 39.00 21.00 26.00 0.00 12.00 98.00 39.00 21.00 32.00 18.00 20.00 130.00 PV PV CV CV SV SV Performance Indexes Summary Period EV AC 2 4 EACf 6 8 33.00 60.00 98.00 130.00 VACf = PV SPI CPI PCI-B % % %
