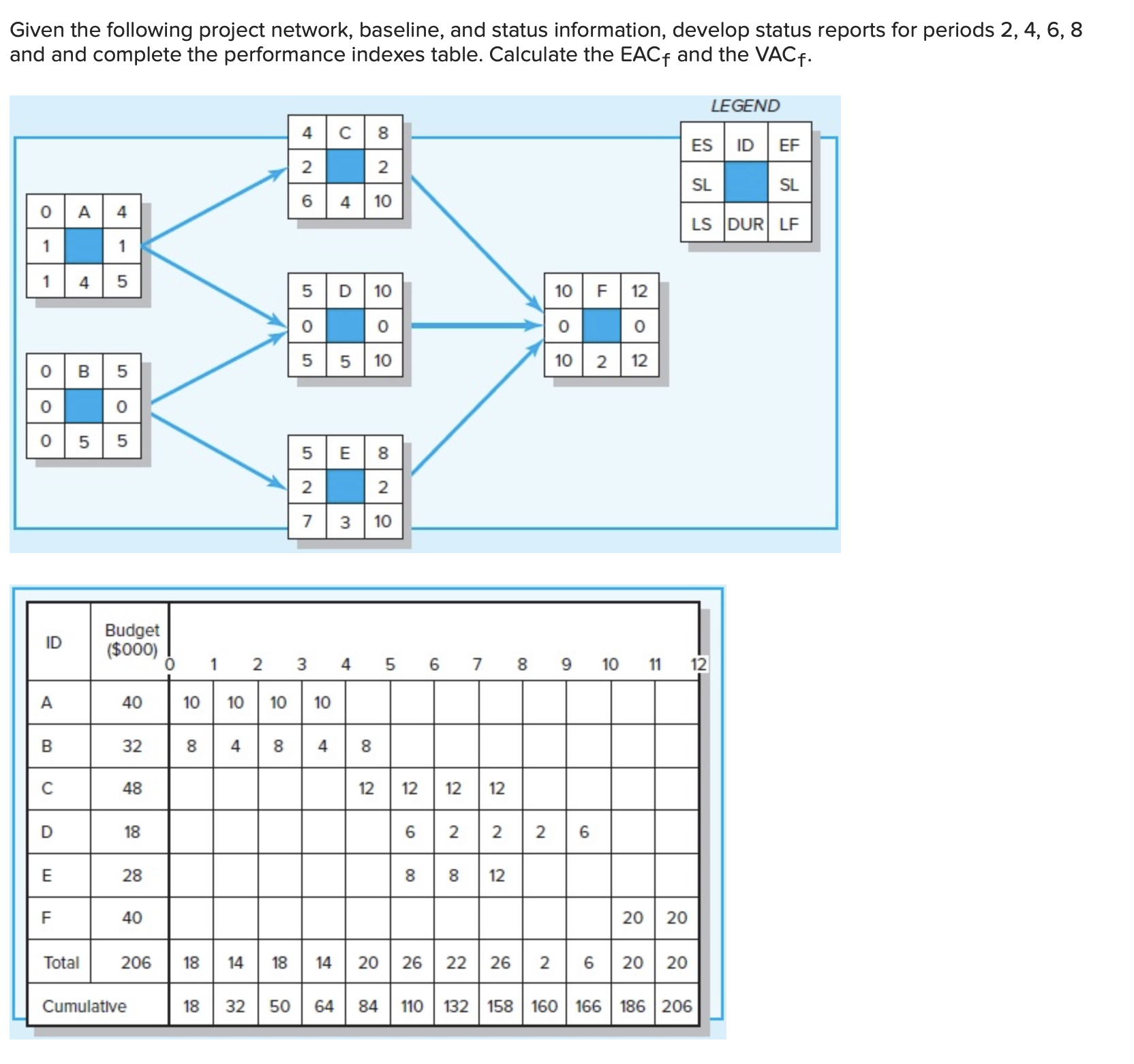

Question: Given the following project network, baseline, and status information, develop status reports for periods 2, 4, 6, 8 and and complete the performance indexes table.






Given the following project network, baseline, and status information, develop status reports for periods 2, 4, 6, 8 and and complete the performance indexes table. Calculate the EAC and the VAC. LEGEND 4 C 8 ES ID EF 2 2 SL SL 6 4 10 0 A 4 LS DUR LF 4 5 5 D 10 10 F 12 O O O O 5 5 10 10 2 12 O B 5 O O 5 5 5 E 8 2 2 7 3 10 Budget ID ($000) 3 4 5 6 7 8 9 10 11 12 A 40 10 10 10 B 32 C Bt 12 12 12 12 D 21 2 2 2 6 F 8 12 40 20 20 Total 206 18 14 19 14 20 26 22 26 20 20 Cumulative 18 32 50 64 84 110 132 158 160 166 186 206(Do not round intermediate calculations. Enter all answers to 2 decimal precision. Enter PCI-B in percent format (e.g., enter 73.05% if the decimal equivalent is 0.7305.) Status Report: Ending Period 2 Task % Complete EV AC PV CV SV A 80.00 29.00 B 40.00 14.00 Cumulative Totals 43.00 Status Report: Ending Period 4 Task % Complete EV AC PV CV SV A 100 39.00 B 100 23.00 Cumulative Totals 62.00 Status Report: Ending Period 6 Task % Complete EV AC PV CV SV A 100 39.00 B 100 23.00 C 70.00 26.00 D 0 0.00 F 50.00 12.00 Cumulative Totals 100.00Status Report: Ending Period 8 Task % Complete EV AC PV CV SV A 100 39.00 B 100 23.00 C 100 34.00 D 30.00 19.00 E 100 20.00 Cumulative Totals 135.00 Performance Indexes Summary Period EV AC PV SPI CPI PCI-B 2 43.00 4 62.00 6 100.00 8 135.00 EACf = VACf
Step by Step Solution
There are 3 Steps involved in it
Get step-by-step solutions from verified subject matter experts
