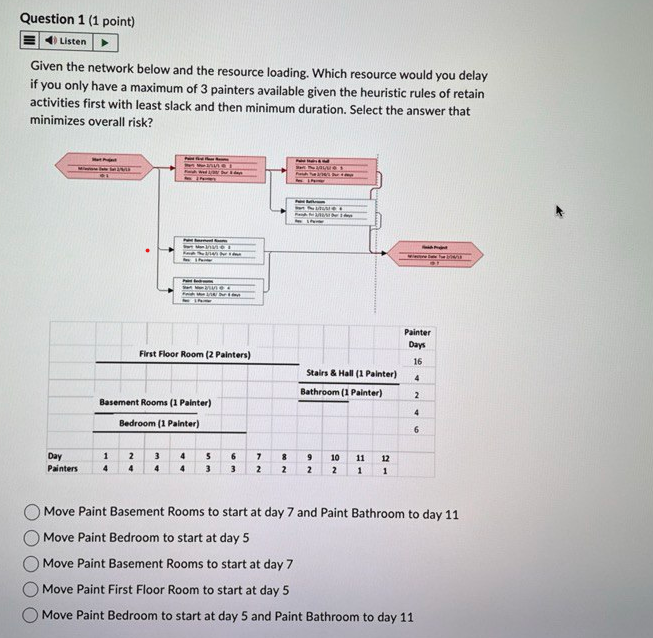

Question: Given the network below and the resource loading. Which resource would you delay if you only have a maximum of 3 painters available given the

Given the network below and the resource loading. Which resource would you delay if you only have a maximum of 3 painters available given the heuristic rules of retain activities first with least slack and then minimum duration. Select the answer that minimizes overall risk? Move Paint Basement Rooms to start at day 7 and Paint Bathroom to day 11 Move Paint Bedroom to start at day 5 Move Paint Basement Rooms to start at day 7 Move Paint First Floor Room to start at day 5 Move Paint Bedroom to start at day 5 and Paint Bathroom to day 11
