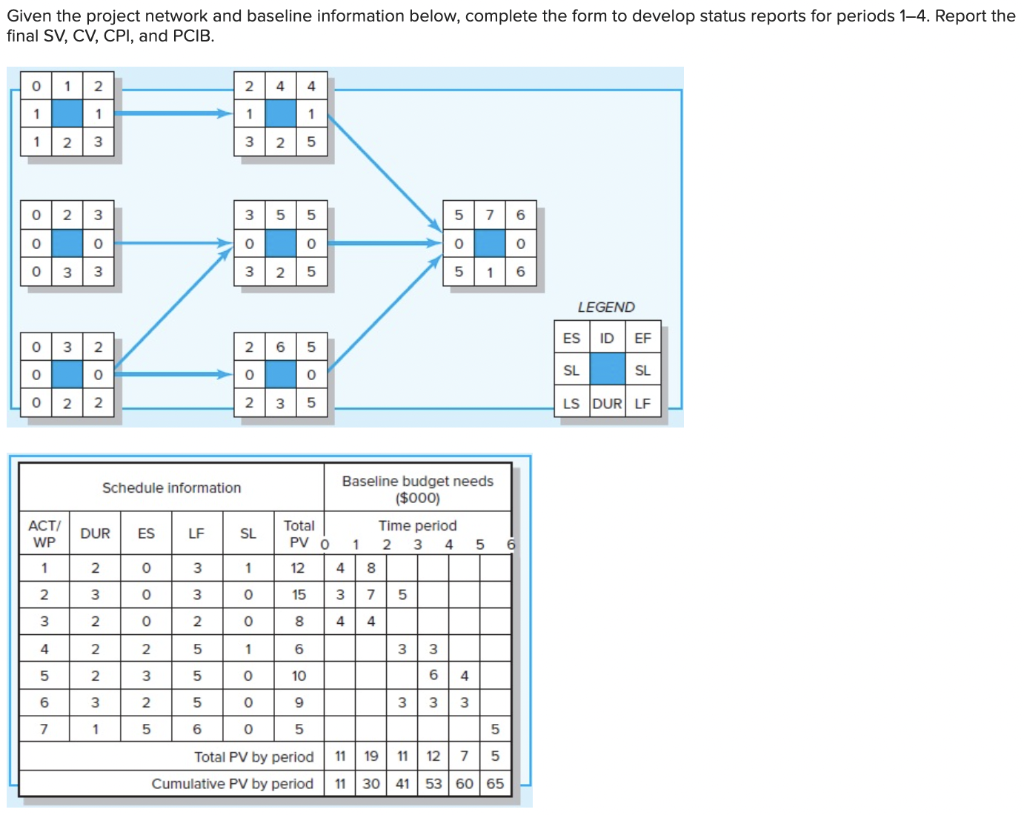

Question: Given the project network and baseline information below, complete the form to develop status reports for periods 14. Report the final SV, CV, CPI, and

Given the project network and baseline

Given the project network and baseline

Given the project network and baseline

Given the project network and baseline information below, complete the form to develop status reports for periods 14. Report the final SV, CV, CPI, and PCIB. (Do not round intermediate calculations. Enter all answers to 2 decimal places. For SPI, CPI, and PCI-B, enter your answers as decimals rather than percentage format (e.g., enter 0.93 instead of 93%).)
