Question: Help me with the work and if these are right? The data identified below was listed in a project's latest status report: a. PV =
Help me with the work and if these are right?

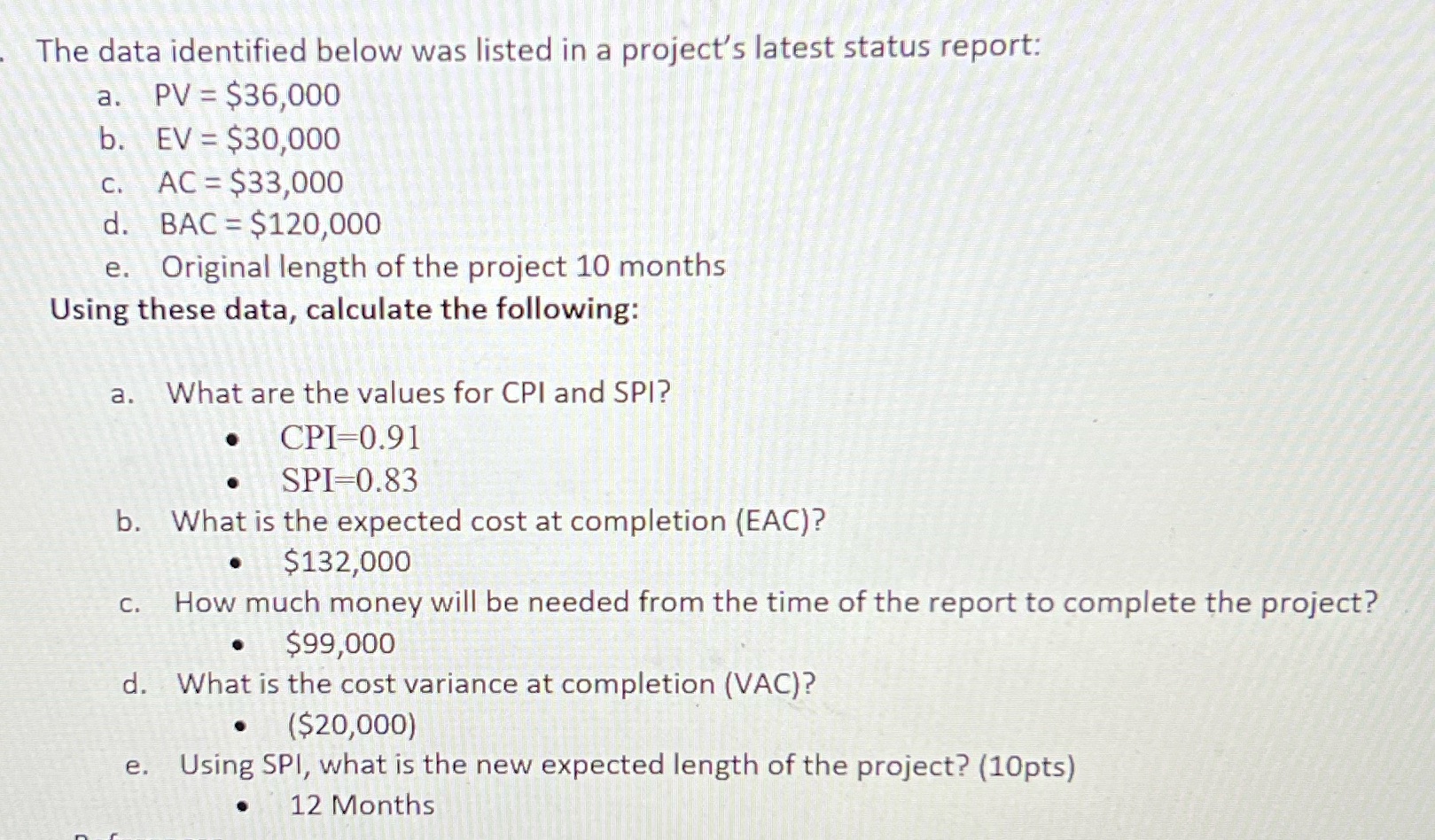

The data identified below was listed in a project's latest status report: a. PV = $36,000 b. EV = $30,000 C. AC = $33,000 d. BAC = $120,000 e. Original length of the project 10 months Using these data, calculate the following: a. What are the values for CPI and SPI? CPI-0.91 SPI=0.83 b. What is the expected cost at completion (EAC)? $132,000 c. How much money will be needed from the time of the report to complete the project? $99,000 d. What is the cost variance at completion (VAC)? . ($20,000) e. Using SPI, what is the new expected length of the project? (10pts) 12 Months
