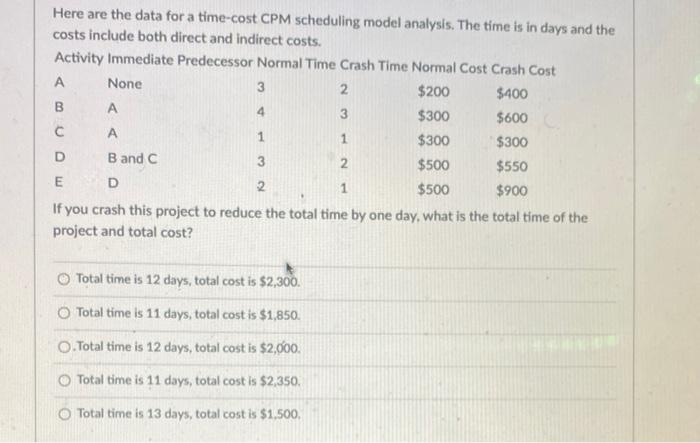

Question: help pls 00 4 Here are the data for a time-cost CPM scheduling model analysis. The time is in days and the costs include both
help pls
00 4 Here are the data for a time-cost CPM scheduling model analysis. The time is in days and the costs include both direct and indirect costs. Activity Immediate Predecessor Normal Time Crash Time Normal Cost Crash Cost A None 3 2 $200 $400 3 $300 $600 1 $300 $300 Band C 2 $500 $550 E D 2 1 $500 $900 If you crash this project to reduce the total time by one day, what is the total time of the project and total cost? B C 1 D 3 Total time is 12 days, total cost is $2,300. Total time is 11 days, total cost is $1,850. O. Total time is 12 days, total cost is $2,000. Total time is 11 days, total cost is $2,350 Total time is 13 days, total cost is $1,500
