Question: I need help with the following exercise: If the indirect costs for each duration are $300 for 27 days, $240 for 26 days, $180 for
I need help with the following exercise:

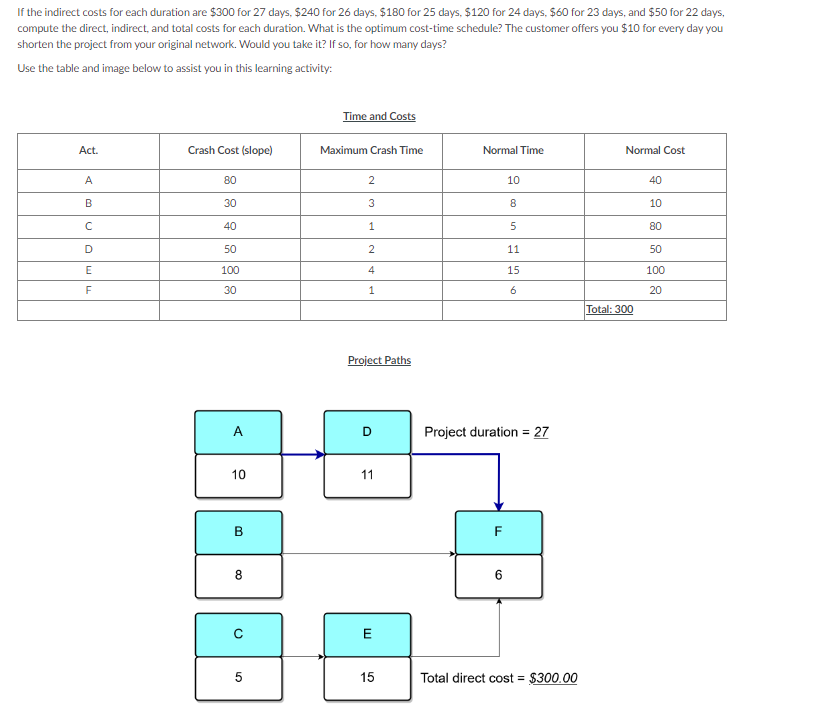

If the indirect costs for each duration are $300 for 27 days, $240 for 26 days, $180 for 25 days, $120 for 24 days, $60 for 23 days, and $50 for 22 days, compute the direct, indirect, and total costs for each duration. What is the optimum cost-time schedule? The customer offers you $10 for every day you shorten the project from your original network. Would you take it? If so, for how many days? Use the table and image below to assist you in this learning activity: Time and Costs Act. Crash Cost (slope) Maximum Crash Time Normal Time Normal Cost A 80 2 10 40 B 30 3 8 10 C 40 1 5 80 D 50 2 11 50 100 4 15 100 F 30 1 6 20 Total: 300 Project Paths A D Project duration = 27 10 11 B F 8 6 C E 5 15 Total direct cost = $300.00
