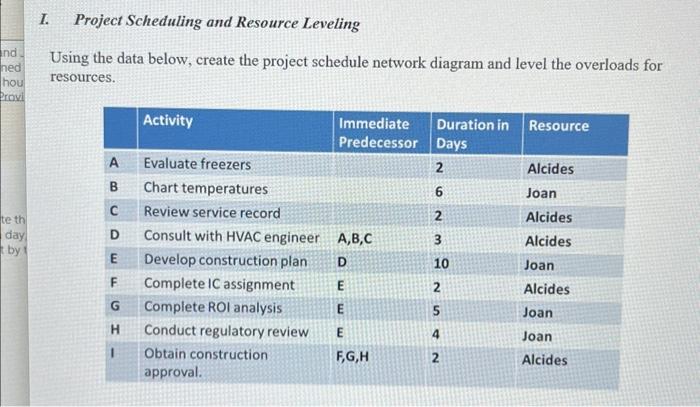

Question: I. Project Scheduling and Resource Leveling Using the data below, create the project schedule network diagram and level the overloads for resources. b. Develop a

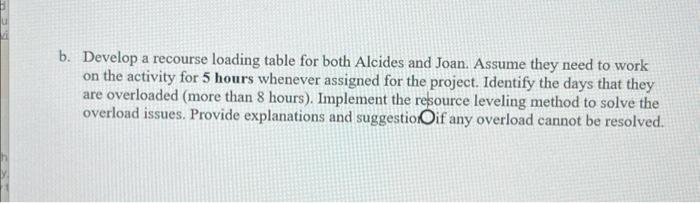

I. Project Scheduling and Resource Leveling Using the data below, create the project schedule network diagram and level the overloads for resources. b. Develop a recourse loading table for both Alcides and Joan. Assume they need to work on the activity for 5 hours whenever assigned for the project. Identify the days that they are overloaded (more than 8 hours). Implement the resource leveling method to solve the overload issues. Provide explanations and suggestionif any overload cannot be resolved
