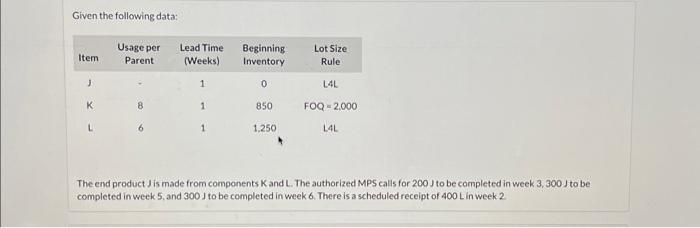

Question: need help with part a Given the following data: The end product J is made from components K and L. The authorized MPS calls for

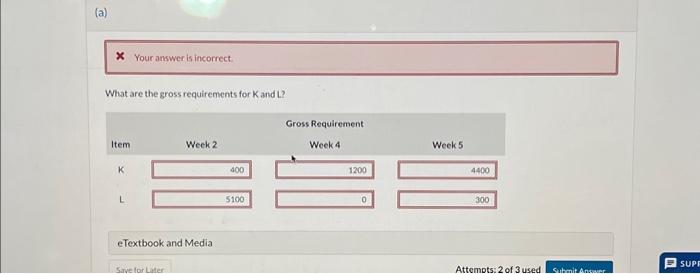

Given the following data: The end product J is made from components K and L. The authorized MPS calls for 200J to be completed in week 3,300J to be completed in week 5 , and 300J to be completed in week 6 . There is a scheduled receipt of 400L in week 2 What are the gross requirements for K and L
