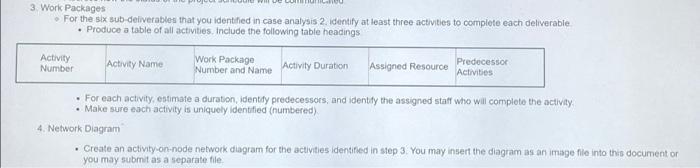

Question: Network diagram. Create an activity on node network diagram 3. Work Packages For the six sub-deliverables that you identified in case analysis 2 Identity at

Network diagram. Create an activity on node network diagram
Network diagram. Create an activity on node network diagram 3. Work Packages
For the six sub-deliverables that you identified in case analysis 2 Identity
at least three activities to complete each deliverable . Produce a table
of all activities. Include the following table headings Activity Number Activity Name

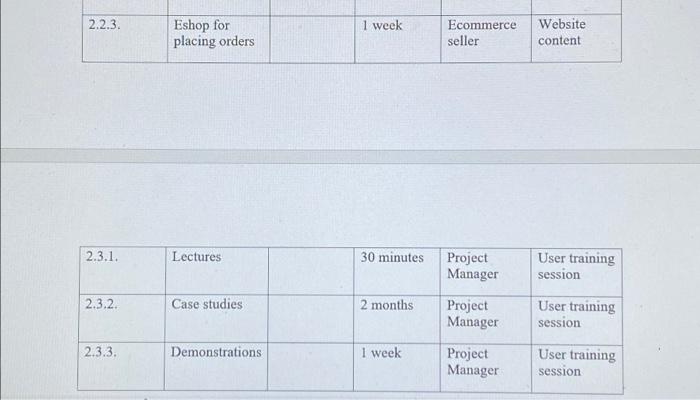

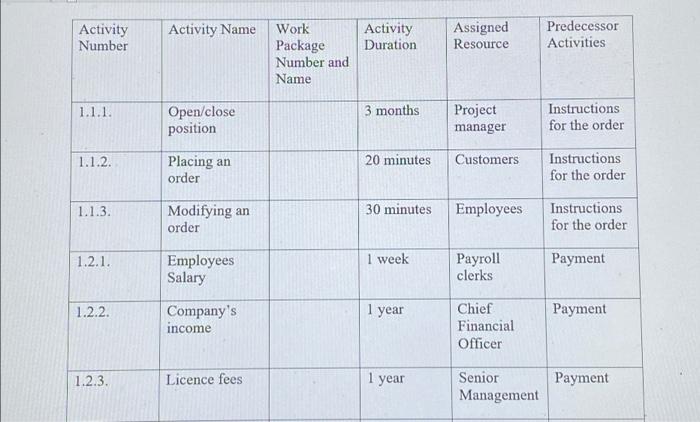

3. Work Packages For the six sub-deliverables that you identified in case analysis 2 Identity at least three activities to complete each deliverable . Produce a table of all activities. Include the following table headings Activity Number Activity Name Work Package Number and Name Activity Duration Assigned Resource Predecesso Activities . For each activity, estimate a duration, Identity predecessors, and identify the assigned staff who will complete the activity Make sure each activity is uniquely identified (numbered) 4. Network Diagram Create an activity on-node network diagram for the activities identified in step 3. You may insert the diagram as an image file into this document or you may submit as a separate file Activity Number Activity Name Activity Duration Assigned Resource Predecessor Activities Work Package Number and Name 1.1.1. 3 months Open/close position Project manager Instructions for the order 1.1.2. 20 minutes Customers Placing an order Instructions for the order 1.1.3. 30 minutes Employees Modifying an order Instructions for the order 1.2.1. 1 week Employees Salary Payroll clerks Payment 1.2.2. 1 year Payment Company's income Chief Financial Officer 1.2.3. Licence fees 1 year Payment Senior Management 1.3.1 Material used 3 months Content Senior Management 1.3.2. Problem Solutions 1 year Content Project Manager 1.3.3. Targeting the customers 4 months Content Marketing department 2.1.1. Latest business 1 week Business Analysis Software report news 2.1.2 2 months Investment activity Finance Analysis Software report 2.1.3. 5 months Corporate developments in the software Software developers Software report 2.2.1. Written content 7 hours Web content writer Website content 2.2.2. Drop-shipping site 2 weeks Web content creator Website content 2.2.3. 1 week Eshop for placing orders Ecommerce seller Website content 2.3.1. Lectures 30 minutes Project Manager User training session 2.3.2. Case studies 2 months Project Manager User training session 2.3.3. Demonstrations 1 week Project Manager User training session

Step by Step Solution

There are 3 Steps involved in it

1 Expert Approved Answer
Step: 1 Unlock blur-text-image
Question Has Been Solved by an Expert!

Get step-by-step solutions from verified subject matter experts

Step: 2 Unlock
Step: 3 Unlock

Students Have Also Explored These Related Accounting Questions!
