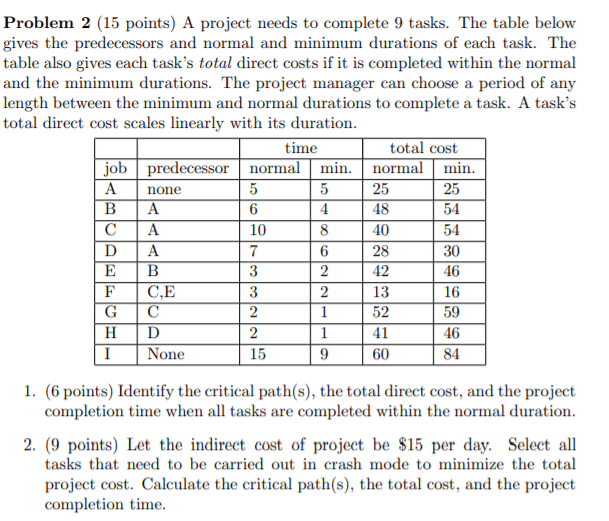

Question: none 25 25 Problem 2 (15 points) A project needs to complete 9 tasks. The table below gives the predecessors and normal and minimum durations
