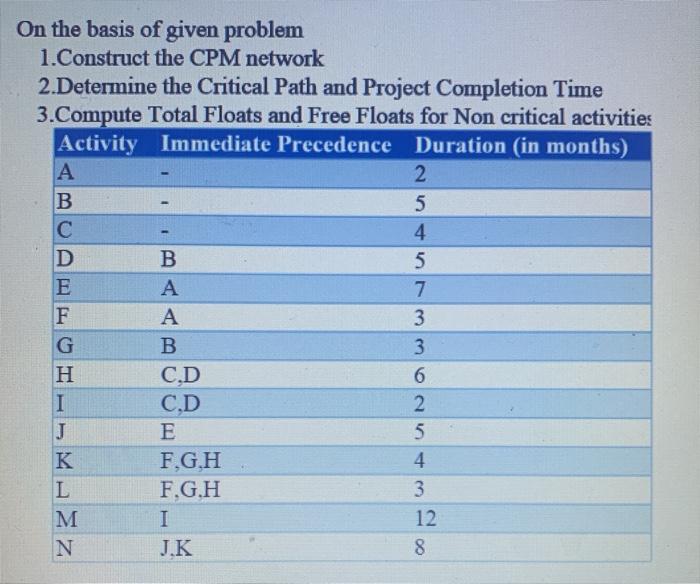

Question: On the basis of given problem 1.Construct the CPM network 2.Determine the Critical Path and Project Completion Time 3.Compute Total Floats and Free Floats for

On the basis of given problem 1.Construct the CPM
On the basis of given problem 1.Construct the CPM network 2.Determine the Critical Path and Project Completion Time 3.Compute Total Floats and Free Floats for Non critical activities Activity Immediate Precedence Duration (in months) 2 B 5 4 D B 5 E A 7 F A 3 G B 3 H C.D 6 I C.D 2 J E 5 K F.GH 4 L L F.G.H 3 M I 12 N J.K 8
