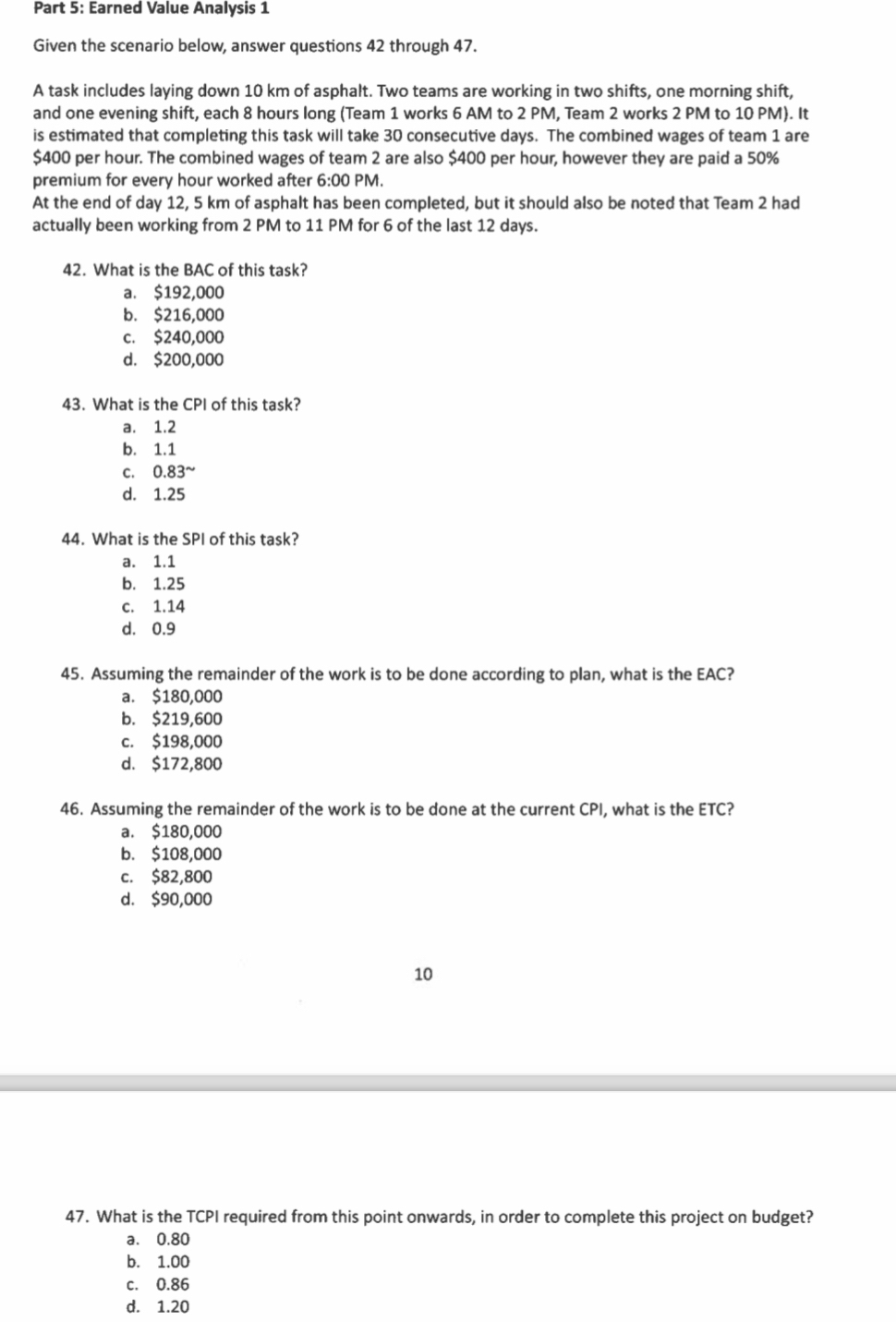

Question: Part 5 : Earned Value Analysis 1 Given the scenario below, answer questions 4 2 through 4 7 . A task includes laying down 1

Part 5: Earned Value Analysis 1
Given the scenario below, answer questions 42 through 47.
A task includes laying down 10km of asphalt. Two teams are working in two shifts, one morning shift, and one evening shift, each 8 hours long (Team 1 works 6 AM to 2 PM, Team 2 works 2 PM to 10 PM). It is estimated that completing this task will take 30 consecutive days. The combined wages of team 1 are $400 per hour. The combined wages of team 2 are also $400 per hour, however they are paid a 50% premium for every hour worked after 6:00 PM.
At the end of day 12,5km of asphalt has been completed, but it should also be noted that Team 2 had actually been working from 2 PM to 11 PM for 6 of the last 12 days.
42. What is the BAC of this task?
a. $192,000
b. $216,000
c. $240,000
d. $200,000
43. What is the CPI of this task?
a.1.2
b.1.1
c.0.83
d.1.25
44. What is the SPI of this task?
a.1.1
b.1.25
c.1.14
d.0.9
45. Assuming the remainder of the work is to be done according to plan, what is the EAC?
a. $180,000
b. $219,600
c. $198,000
d. $172,800
46. Assuming the remainder of the work is to be done at the current CPI, what is the ETC?
a. $180,000
b. $108,000
c. $82,800
d. $90,000
10
47. What is the TCPI required from this point onwards, in order to complete this project on budget?
a.0.80
b.1.00
c.0.86
d.1.20
 Part 5: Earned Value Analysis 1 Given the scenario below, answer

Step by Step Solution

There are 3 Steps involved in it

1 Expert Approved Answer
Step: 1 Unlock blur-text-image
Question Has Been Solved by an Expert!

Get step-by-step solutions from verified subject matter experts

Step: 2 Unlock
Step: 3 Unlock

Students Have Also Explored These Related General Management Questions!
