Question: please explain and show work. d has no predecessor as you can see in the table. Given the project within the table below, calculate the

please explain and show work. d has noplease explain and show work. d has no

please explain and show work. d has no predecessor as you can see in the table.

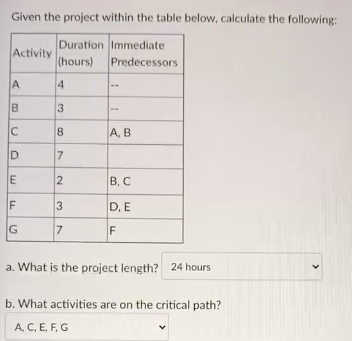

Given the project within the table below, calculate the following: Duration Immediate Activity (hours) Predecessors | 4 B 3 IC 8 |A, B D 7 E 2 B, C F 3 D, E G 7 F a. What is the project length? 24 hours b. What activities are on the critical path? A, C, E, F, G c. How much slack in in activity B? 1 hour d. What is the Late Start / Late Finish for activity D? 0 hours and 7 hours f. What if activity D was delayed by 8 hours (now taking 15 hours), what impact would it have on the overall project? It would have no impact - the

Step by Step Solution

There are 3 Steps involved in it

1 Expert Approved Answer
Step: 1 Unlock blur-text-image
Question Has Been Solved by an Expert!

Get step-by-step solutions from verified subject matter experts

Step: 2 Unlock
Step: 3 Unlock

Students Have Also Explored These Related General Management Questions!
