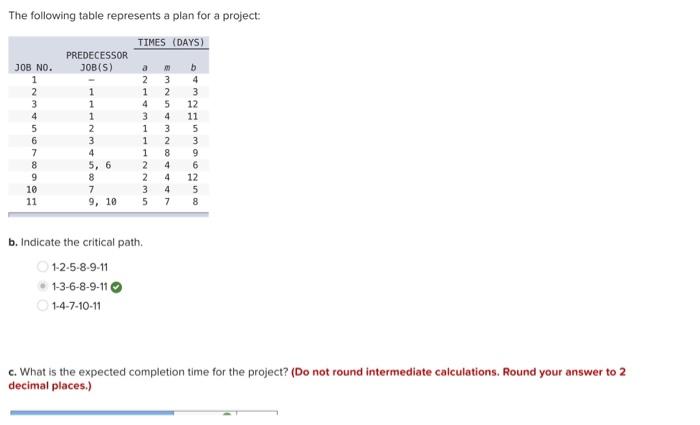

Question: please give correct answer to question E c. What is the expected completion time for the project? (Do not round intermediate calculations. Round your answer

please give correct answer to question E
please give correct answer to question E c. What is the expected
completion time for the project? (Do not round intermediate calculations. Round your

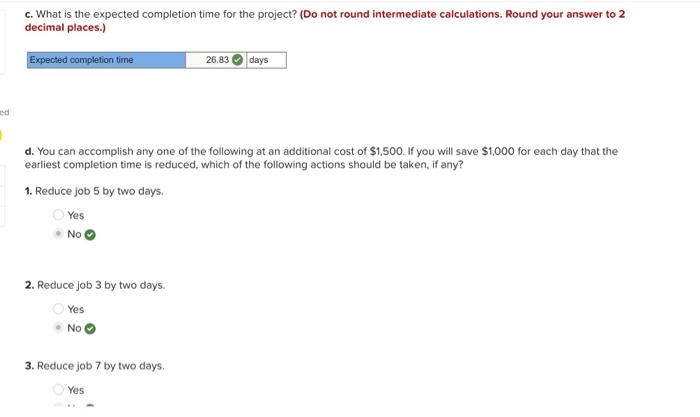

answer to 2 decimal places.) Expected completion time 26.83 days d. You

c. What is the expected completion time for the project? (Do not round intermediate calculations. Round your answer to 2 decimal places.) Expected completion time 26.83 days d. You can accomplish any one of the following at an additional cost of $1,500. If you will save $1,000 for each day that the earliest completion time is reduced, which of the following actions should be taken, if any? 1. Reduce job 5 by two days. Yes No 2. Reduce job 3 by two days. Yes No 3. Reduce job 7 by two days. Yes The following table represents a plan for a project: b. Indicate the critical path. 125891113689111471011 c. What is the expected completion time for the project? (Do not round intermediate calculations. Round your answer to 2 decimal places.) 2. Reduce job 3 by two days. Yes No 3. Reduce job 7 by two days. Yes No e. What is the probability that the project will take more than 30 days to complete? (Use Excel's NORMSDIST) function to find the correct probability for your computed Z-value. Other than the expected completion time you entered in part c above, do not round intermediate calculations. Round " z " value to 2 decimal places your final answer to 4 decimal places.)

Step by Step Solution

There are 3 Steps involved in it

1 Expert Approved Answer
Step: 1 Unlock blur-text-image
Question Has Been Solved by an Expert!

Get step-by-step solutions from verified subject matter experts

Step: 2 Unlock
Step: 3 Unlock

Students Have Also Explored These Related General Management Questions!
