Question: Please help with D, E, and F. Thank you Please help thank you Office Automation, Inc., developed a proposal for introducing a new computerized office

Please help with D, E, and F. Thank you
Please help thank you

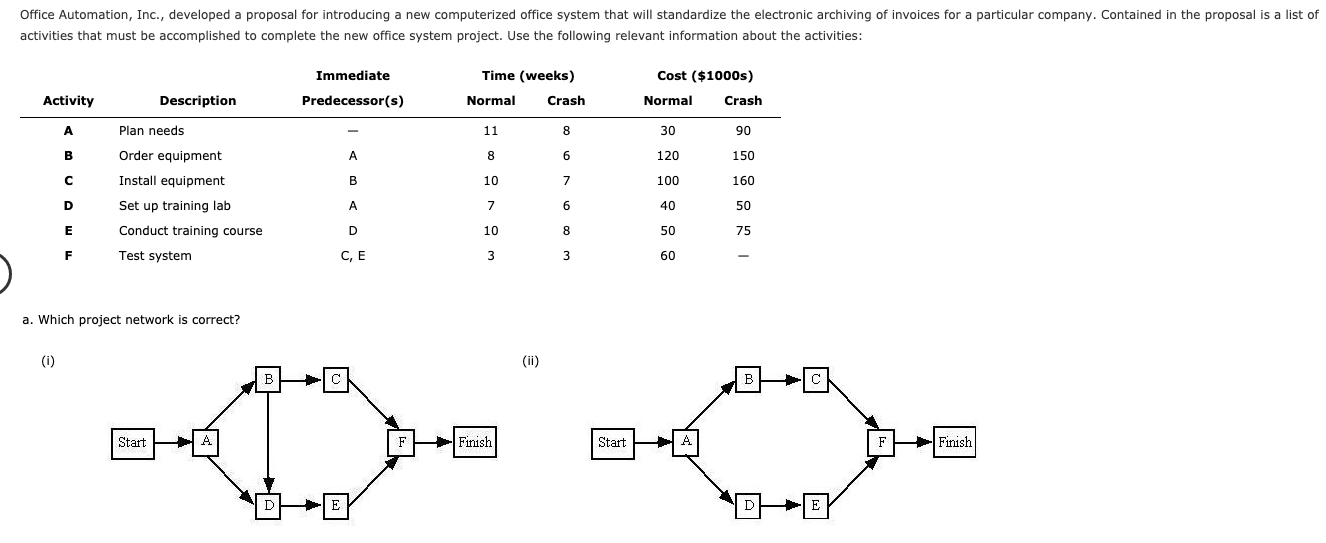

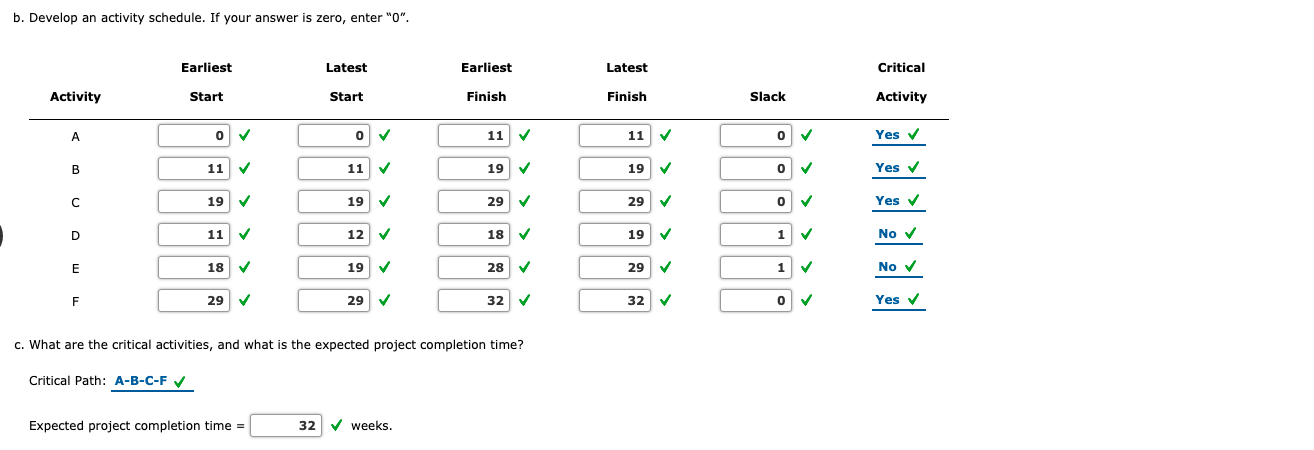

Office Automation, Inc., developed a proposal for introducing a new computerized office system that will standardize the electronic archiving of invoices for a particular company. Contained in the proposal is a list of activities that must be accomplished to complete the new office system project. Use the following relevant information about the activities: Immediate Time (weeks) Normal Crash Cost ($1000s) Normal Crash Activity Description Predecessor(s) A Plan needs 11 8 30 90 B Order equipment 8 6 120 150 Install equipment 10 7 100 160 D Set up training lab A 7 6 40 50 E D D 10 8 50 75 Conduct training course Test system F C, E 3 3 60 a. Which project network is correct? (i) (ii) B - C B Start A F Finish Start F Finish D E DHE b. Develop an activity schedule. If your answer is zero, enter "O". Latest Earliest Earliest Latest Earliest Start Critical Activity Start Finish Finish Slack Activity A o o 11 11 0 Yes B B 11 11 19 19 o Yes 19 19 29 29 o Yes D 11 12 18 19 1 No E 18 19 28 29 1 No F 29 29 32 32 o Yes c. What are the critical activities, and what is the expected project completion time? Critical Path: A-B-C-F Expected project completion time = 32 weeks. c. What are the critical activities, and what is the expected project completion time? Critical Path: A-B-C-F Expected project completion time = 32 weeks. d. Assume that the company wants to complete the project in six months or 26 weeks. What crashing decisions do you recommend to meet the desired completion time at the least possible cost? Work through the network and attempt to make the crashing decisions by inspection. Crash Activities Number of Weeks Cost ($1000s) A 3 60 B 2 30 1 20 D 1 10 E 1 0 120 e. Develop an activity schedule for the crashed project. If your answer is zero, enter "O". Earliest Latest Earliest Latest Critical Activity Start Start Finish Finish Slack Slack Activity A 0 o 8 8 o Yes B 8 9 x 14 15 X 1 X Yes 14 15 X 21 X 22 X 1 X Yes D 8 8 14 14 0 Yes E 14 14 22 X 22 X 0 Yes F 22 X 22 X 25 X 25 x 0 Yes f. What added project cost is required to meet the six-month completion time? Total added cost due to crashing $ 8,000 XStep by Step Solution
There are 3 Steps involved in it
1 Expert Approved Answer
Step: 1 Unlock
Question Has Been Solved by an Expert!
Get step-by-step solutions from verified subject matter experts
Step: 2 Unlock
Step: 3 Unlock
