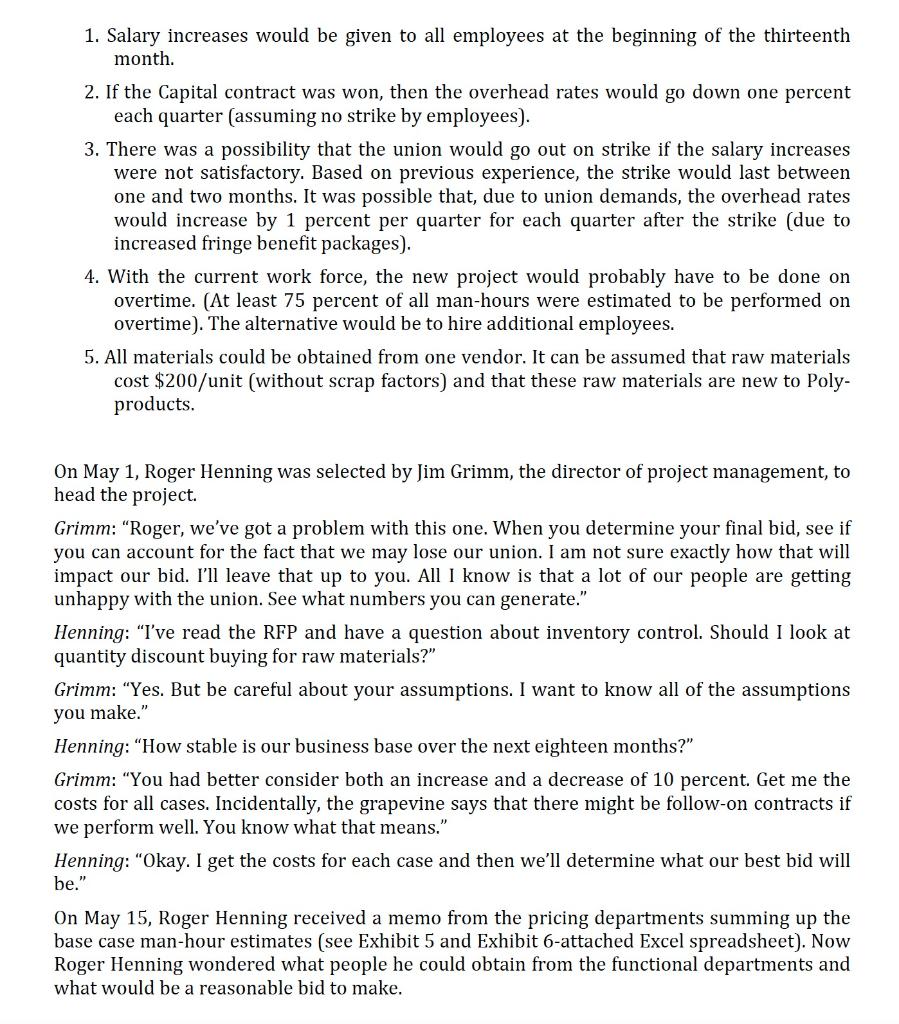

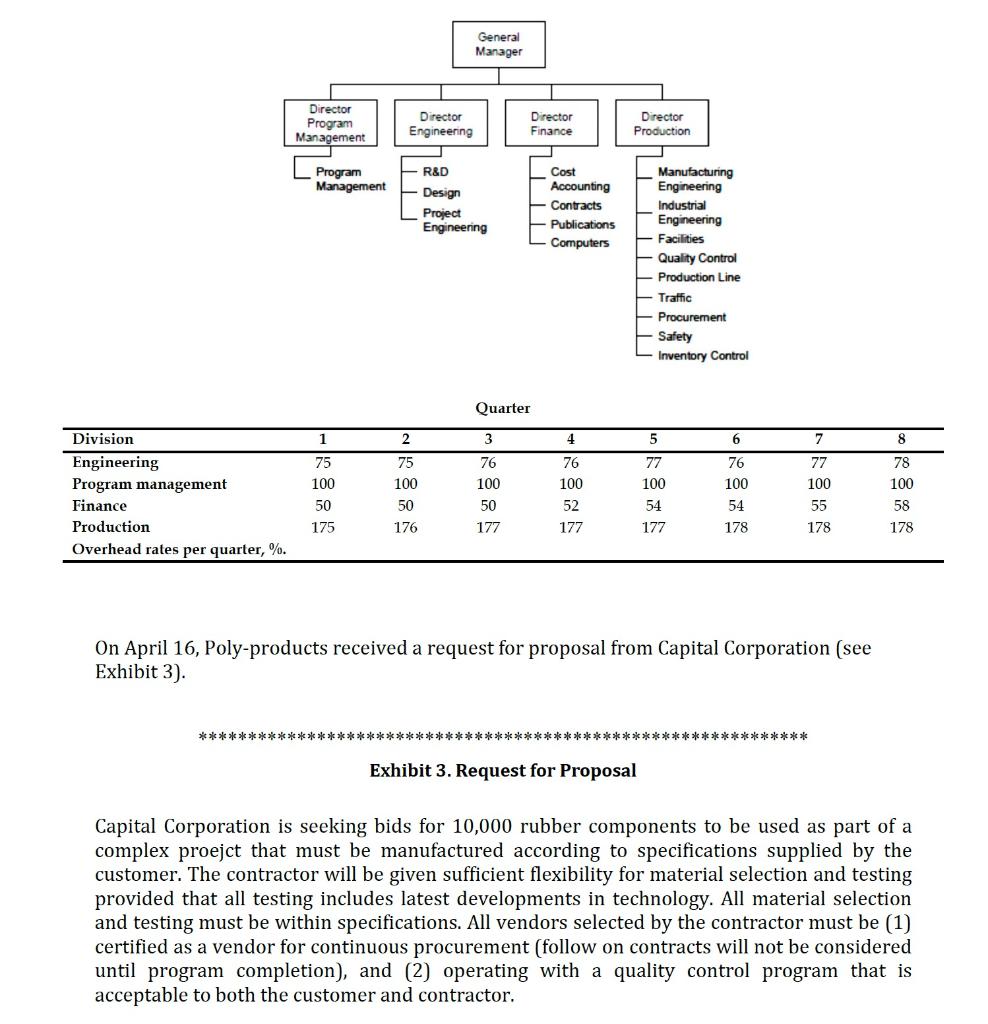

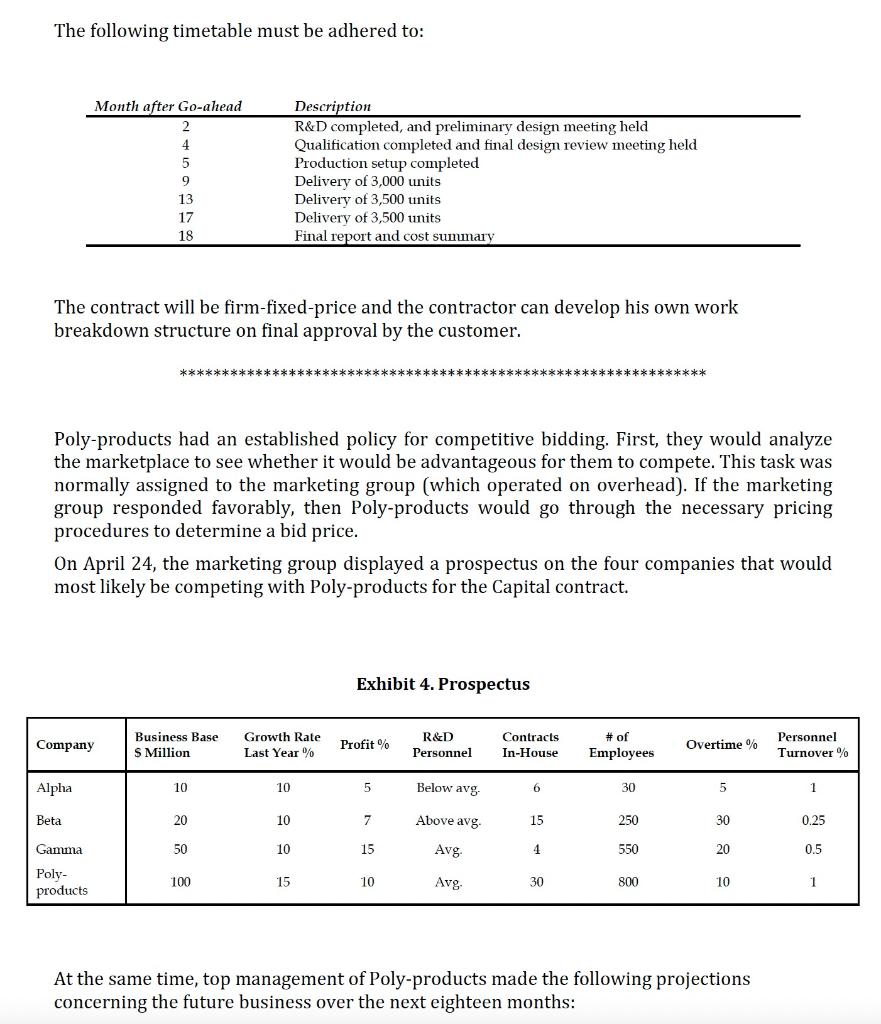

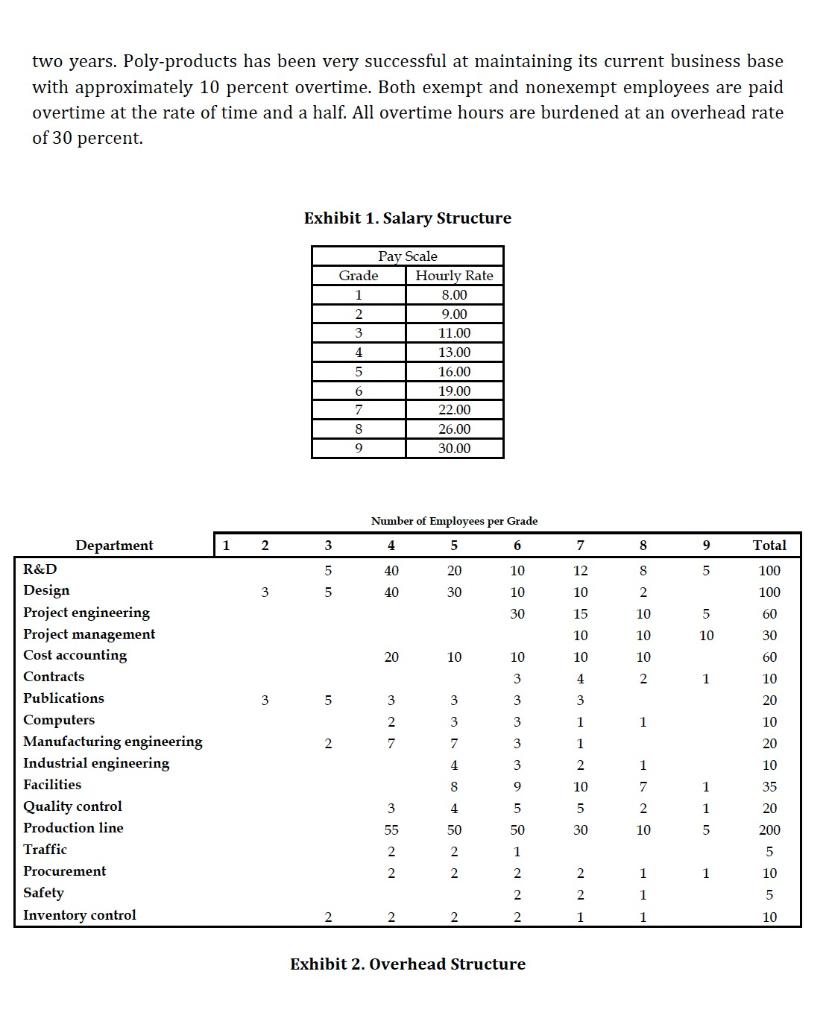

Please see the following Instruction and POLYPRODUCTS INC. Case Study documents. These are complete documents. Can you please prepare a document to answer all questions?
