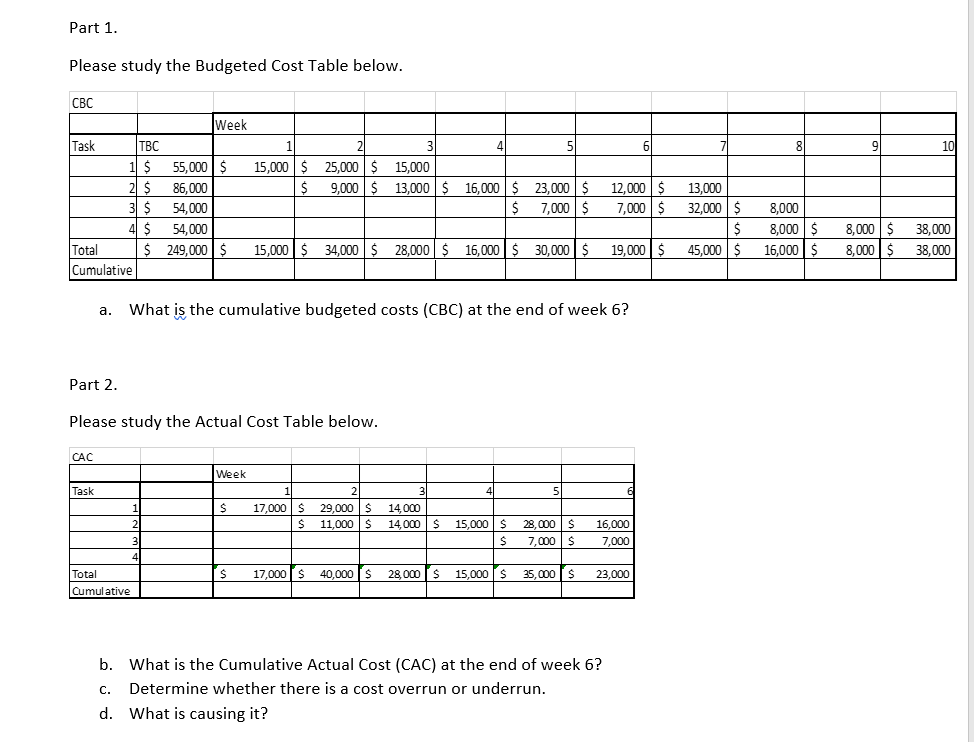

Question: Please study the Budgeted Cost Table below. a. What is the cumulative budgeted costs (CBC) at the end of week 6 ? Part 2. Please

Please study the Budgeted Cost Table below. a. What is the cumulative budgeted costs (CBC) at the end of week 6 ? Part 2. Please study the Actual Cost Table below. b. What is the Cumulative Actual Cost (CAC) at the end of week 6 ? c. Determine whether there is a cost overrun or underrun. d. What is causing it? Please study the Cumulative Percentage Complete (CPC) table below. e. Develop a Cumulative Earned Value (CEV) table and present it below. f. What is the CEV of the project at the end of week 6 ? g. Is it good? Explain. Part 4. Using the tables for this project: h. What is the CPI at the end of week 6 ? i. What is the CV? j. Calculate the FCAC using the two methods k. In narrative form, describe a third method for calculating FCAC, if you had access to the project task managers for Task 3 and Task 4
