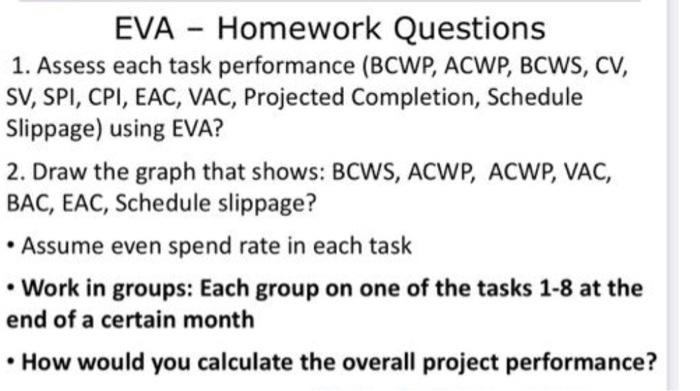

Question: PROGRAM: PROJECT MANAGEMENT EVA - Group Work A seven month project contains eight major tasks with cost and schedule shown in the following Gantt Chart:
PROGRAM: PROJECT MANAGEMENT

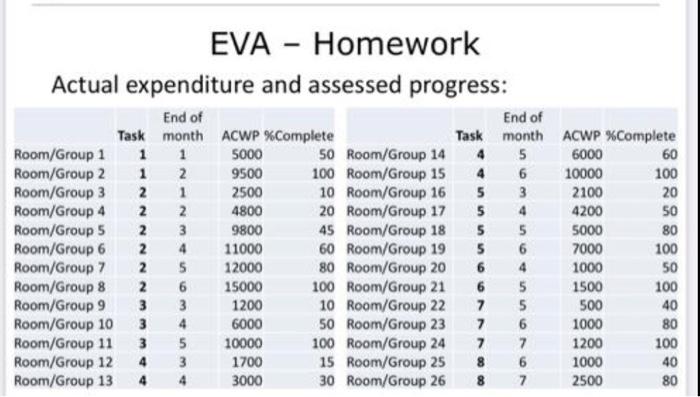

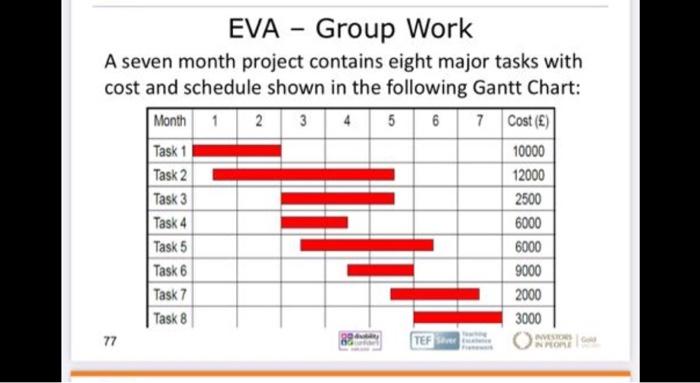

EVA - Group Work A seven month project contains eight major tasks with cost and schedule shown in the following Gantt Chart: Month 1 23 4 5 6 7 Cost () Task 1 10000 Task 2 12000 Task 3 2500 Task 4 6000 Task 5 6000 Task 6 9000 Task 7 2000 Task 8 3000 77 TEFS NOM EVA - Homework Actual expenditure and assessed progress: End of End of Task month ACWP%Complete Task month ACWP Complete Room/Group 1 1 1 5000 50 Room/Group 14 4 5 6000 60 Room/Group 2 1 2 9500 100 Room/Group 15 4 6 10000 100 Room/Group 3 2 1 2500 10 Room/Group 16 5 3 2100 20 Room/Group 4 2 2 4800 20 Room/Group 17 5 4 4200 50 Room/Group 5 2 3 9800 45 Room/Group 18 5 5 5000 80 Room/Group 6 2 4 11000 60 Room/Group 19 5 6 7000 100 Room/Group 7 2 5 12000 80 Room/Group 20 6 4 1000 50 Room/Group 8 2 6 15000 100 Room/Group 21 6 5 1500 100 Room/Group 9 3 3 1200 10 Room/Group 22 7 5 40 Room/Group 10 3 4 6000 50 Room/Group 23 7 6 1000 80 Room/Group 11 3 5 10000 100 Room/Group 24 7 7 100 Room/Group 12 3 1700 15 Room/Group 25 8 6 1000 40 Room/Group 13 3000 30 Room/Group 26 8 7 2500 80 500 1200 4 4 EVA - Homework Questions 1. Assess each task performance (BCWP, ACWP, BCWS, CV, SV, SPI, CPI, EAC, VAC, Projected Completion, Schedule Slippage) using EVA? 2. Draw the graph that shows: BCWS, ACWP, ACWP, VAC, BAC, EAC, Schedule slippage? Assume even spend rate in each task Work in groups: Each group on one of the tasks 1-8 at the end of a certain month How would you calculate the overall project performance? EVA - Group Work A seven month project contains eight major tasks with cost and schedule shown in the following Gantt Chart: Month 1 23 4 5 6 7 Cost () Task 1 10000 Task 2 12000 Task 3 2500 Task 4 6000 Task 5 6000 Task 6 9000 Task 7 2000 Task 8 3000 77 TEFS NOM EVA - Homework Actual expenditure and assessed progress: End of End of Task month ACWP%Complete Task month ACWP Complete Room/Group 1 1 1 5000 50 Room/Group 14 4 5 6000 60 Room/Group 2 1 2 9500 100 Room/Group 15 4 6 10000 100 Room/Group 3 2 1 2500 10 Room/Group 16 5 3 2100 20 Room/Group 4 2 2 4800 20 Room/Group 17 5 4 4200 50 Room/Group 5 2 3 9800 45 Room/Group 18 5 5 5000 80 Room/Group 6 2 4 11000 60 Room/Group 19 5 6 7000 100 Room/Group 7 2 5 12000 80 Room/Group 20 6 4 1000 50 Room/Group 8 2 6 15000 100 Room/Group 21 6 5 1500 100 Room/Group 9 3 3 1200 10 Room/Group 22 7 5 40 Room/Group 10 3 4 6000 50 Room/Group 23 7 6 1000 80 Room/Group 11 3 5 10000 100 Room/Group 24 7 7 100 Room/Group 12 3 1700 15 Room/Group 25 8 6 1000 40 Room/Group 13 3000 30 Room/Group 26 8 7 2500 80 500 1200 4 4 EVA - Homework Questions 1. Assess each task performance (BCWP, ACWP, BCWS, CV, SV, SPI, CPI, EAC, VAC, Projected Completion, Schedule Slippage) using EVA? 2. Draw the graph that shows: BCWS, ACWP, ACWP, VAC, BAC, EAC, Schedule slippage? Assume even spend rate in each task Work in groups: Each group on one of the tasks 1-8 at the end of a certain month How would you calculate the overall project performance


Step by Step Solution
There are 3 Steps involved in it
1 Expert Approved Answer
Step: 1 Unlock
Question Has Been Solved by an Expert!
Get step-by-step solutions from verified subject matter experts
Step: 2 Unlock
Step: 3 Unlock
