Question: PROJECT & OPERATIONS MANAGEMENT Question Q1a.Develop network diagram - AON. If the activity time is in days, what is the completion time for the project?
PROJECT & OPERATIONS MANAGEMENT Question
Q1a.Develop network diagram - AON. If the activity time is in days, what is the completion time for the project?

Q1b. New CEO is appointed. There is a slight change in the activity time as shown in the new table. Develop Gantt chart for the project.

Q1b. i) on what date should the staff report begins (activity E) if the project start on 3rd September 2021?
Q1b. ii) on what date the project will be completed?

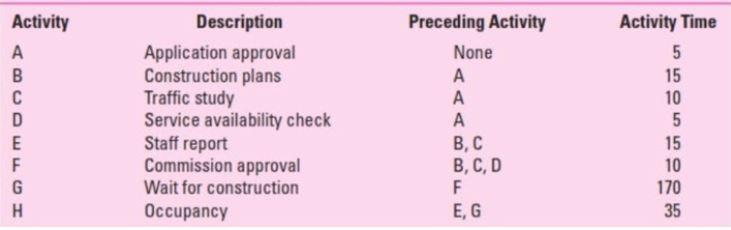

Activity B Description Application approval Construction plans Traffic study Service availability check Staff report Commission approval Wait for construction Occupancy Preceding Activity None A A A B, C B,C,D F E,G Activity Time 5 15 10 5 15 10 170 35 Activity Activity Time 5 B 5 C 3 D 5 E 3 F 5 G 5 H 5Step by Step Solution
