Question: Question 1 4 ( 1 point ) ( checkmark ) Saved A company is doing a software installation project. Here is the

Question 14(1 point)
\(\checkmark \) Saved

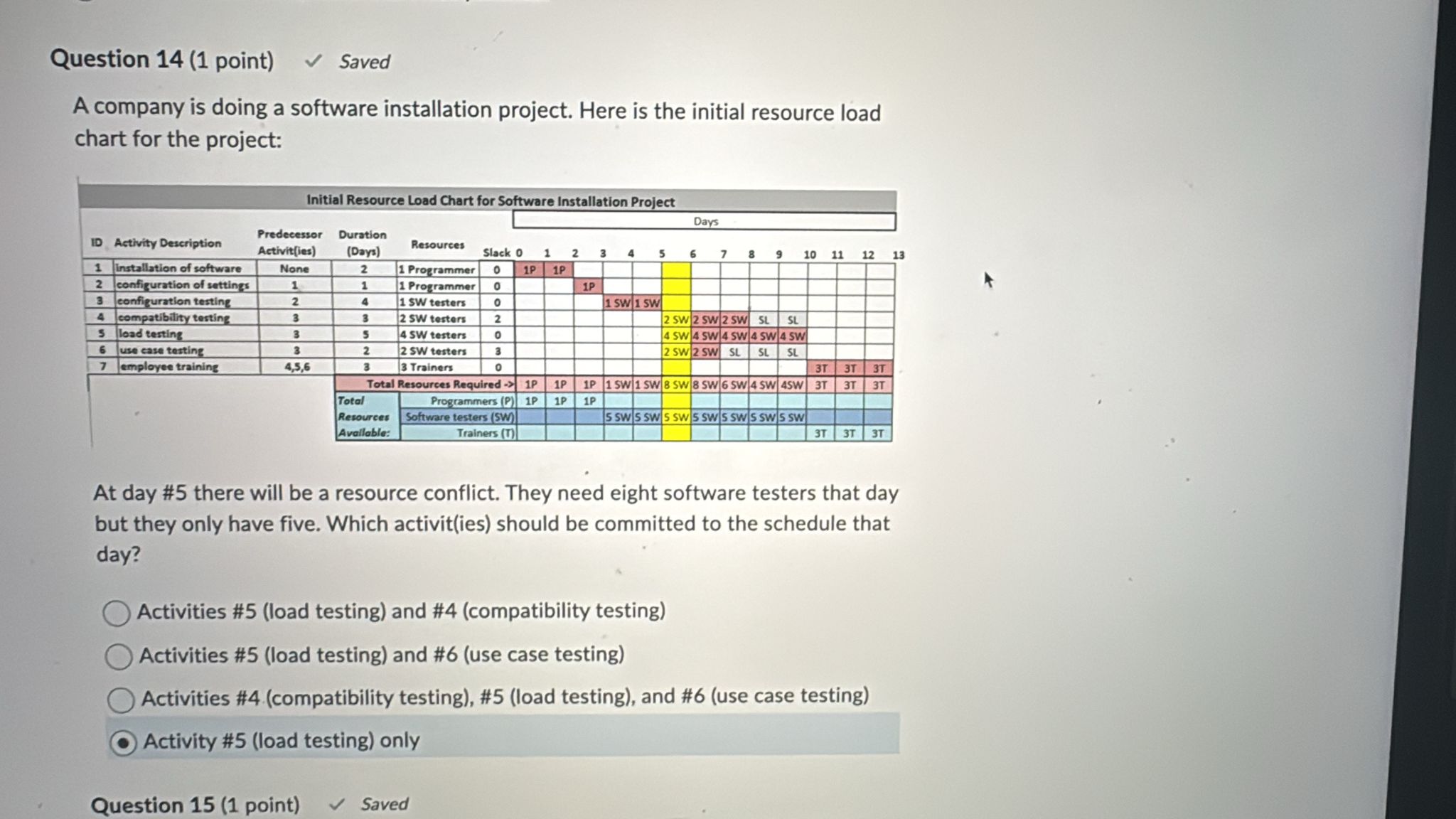

A company is doing a software installation project. Here is the initial resource load chart for the project:
\begin{tabular}{|c|c|c|c|c|c|c|c|c|c|c|c|c|c|c|c|c|c|c|c|}
\hline \multicolumn{20}{|c|}{Initial Resource Load Chart for Software Installation Project}\\
\hline & \multirow[b]{2}{*}{Activity Description} & \multirow[b]{2}{*}{\begin{tabular}{l}
Predecessor \\
Activit(ies)
\end{tabular}} & \multirow[b]{2}{*}{\begin{tabular}{l}
Duration \\
(Days)
\end{tabular}} & \multirow[b]{2}{*}{Resources} & \multirow[b]{2}{*}{Slack} & \multicolumn{14}{|c|}{Days}\\
\hline 10 & & & & & & & 1 & & 34 & 4 & & & 7 & 8 & 9 & & & & 13\\
\hline 1 & Installation of software & None & 2 & 1 Programmer & 0 & \(1 P \) & \(1 P \) & & & & & & & & & & & & \\
\hline 2 & configuration of settings & 1 & 1 & 1 Programmer & 0 & & & iP & & & & & & & & & & & \\
\hline 3 & configuration testing & 2 & 4 & 1 SW testers & 0 & & & & 1 SW & \(15 W \) & & & & & & & & & \\
\hline 4 & compatibility testing & 3 & 3 & 2 SW testers & 2 & & & & & & 2 SW & 25 W & 25W & St & St & & & & \\
\hline 3 & load testing & 3 & 5 & 4 SW testers & 0 & & & & & & 4 SW & 45W & 4 SW & 4 SW & 4 SW & & & & \\
\hline 6 & use case testing & 3 & 2 & 2 SW testers & 3 & & & & & & 2 SW & 25W & SL & SL & St & & & & \\
\hline 7 & employee training & 4,5,6 & 3 & 3 Trainers & 0 & & & & & & & & & & & 31 & 31 & 31 & \\
\hline & \multicolumn{2}{|l|}{\multirow{4}{*}{-}} & \multicolumn{3}{|r|}{Total Resources Required ->} & 18 & 18 & 18 & 1 SW & 1 SW & 8 sw & 8 SW & 65W & 4 SW & 4SW & \(3 T \) & \(3 T \) & \(3 T \) & \\
\hline & & & \multirow[t]{3}{*}{\begin{tabular}{l}
Total \\
Resources \\
Avallable:
\end{tabular}} & \multicolumn{2}{|l|}{Programmers (P)} & \(1 P \) & \(1 P \) & 1 P & & & & & & & & & & & \\
\hline & & & & \multicolumn{2}{|l|}{\multirow[t]{2}{*}{\begin{tabular}{l}
Software testers (SW)\\
Trainers (T)
\end{tabular}}} & & & & 55w & 55w & 5sw & 55w & 55w & 5sw & 5sw & & & & \\
\hline & & & & & & & & & & & & & & & & \(3 T \) & \(3 T \) & \(3 T \) & \\
\hline
\end{tabular}
At day \#5 there will be a resource conflict. They need eight software testers that day but they only have five. Which activit(ies) should be committed to the schedule that day?
Activities \#5(load testing) and \#4(compatibility testing)
Activities \#5(load testing) and \#6(use case testing)
Activities \#4(compatibility testing),\#5(load testing), and \#6(use case testing)
Activity \#5(load testing) only
Question 15(1 point)
Saved
Question 1 4 ( 1 point ) \ ( \ checkmark \ )

Step by Step Solution

There are 3 Steps involved in it

1 Expert Approved Answer
Step: 1 Unlock blur-text-image
Question Has Been Solved by an Expert!

Get step-by-step solutions from verified subject matter experts

Step: 2 Unlock
Step: 3 Unlock

Students Have Also Explored These Related Programming Questions!
