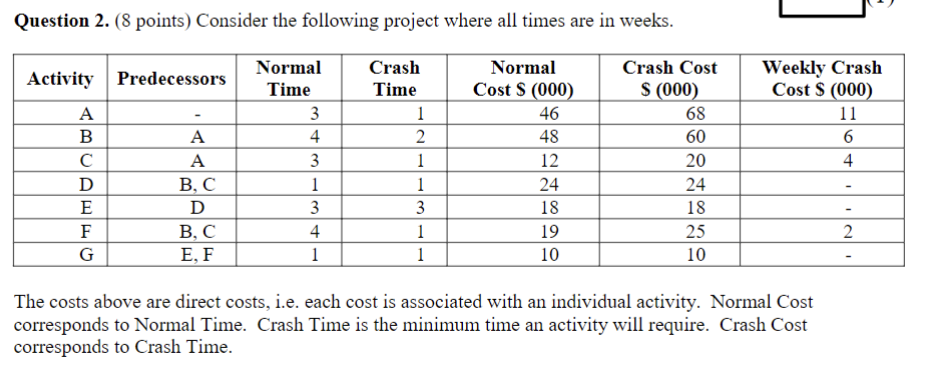

Question: Question 2. (8 points) Consider the following project where all times are in weeks. The costs above are direct costs, i.e. each cost is associated

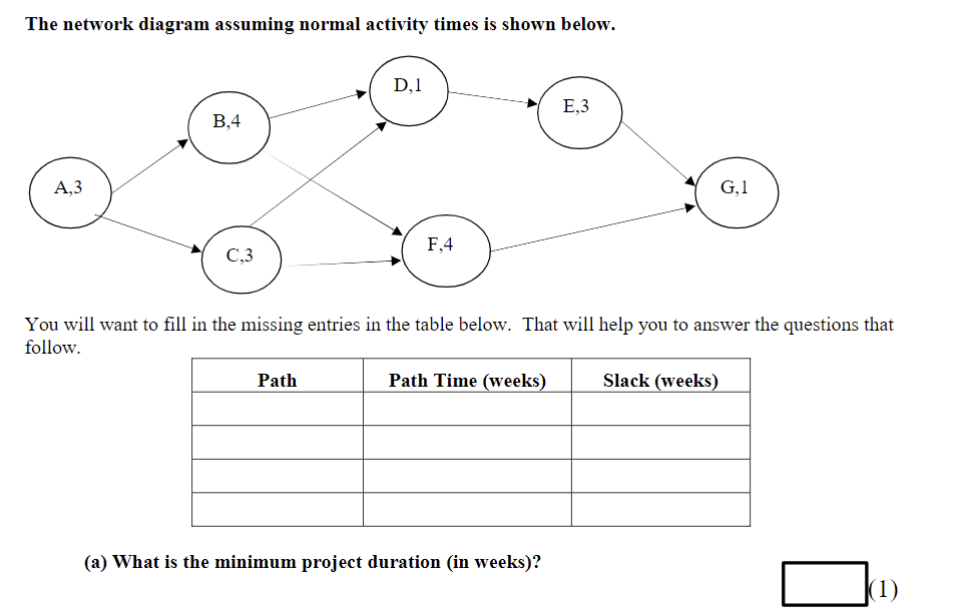

Question 2. (8 points) Consider the following project where all times are in weeks. The costs above are direct costs, i.e. each cost is associated with an individual activity. Normal Cost corresponds to Normal Time. Crash Time is the minimum time an activity will require. Crash Cost corresponds to Crash Time. The network diagram assuming normal activity times is shown below. You will want to fill in the missing entries in the table below. That will help you to answer the questions that follow. (a) What is the minimum project duration (in weeks)? Iou will want to fill in the table below to show clearly the sequence of activities to crash to reduce the duration f the project by a total of four weeks, one week at a time, always at the minimum direct cost. That will help ou to answer the questions that follow. (b) Suppose that the normal project duration is x weeks. Which activities should you crash to reduce the project duration to (x1) weeks? (c) Which activities should you crash to reduce the project duration from (x1) to (x2) weeks? (d) Which activities should you crash to reduce the project duration from (x2) to (x3) weeks? (e) Which activities should you crash to reduce the project duration from (x3) to (x4) weeks? (f) What is the optimal project duration (in weeks) if indirect (overhead) project costs accumulate at the rate of $7,000 per week? ) Suppose that indirect (overhead) project costs accumulate at the rate of $9,000 per week and here is a fine of $3,000 per week for every week by which the project duration exceeds 9 weeks? (i) What is the optimal project duration (in weeks)? (ii) What is the optimal project cost (direct plus indirect plus fine) (in $ )
Step by Step Solution
There are 3 Steps involved in it
Get step-by-step solutions from verified subject matter experts
