Question: Reference the preliminary project schedule (see figure below), answer the following questions. NOTE: The critical path of this project comprises of Tasks 3, 4 and

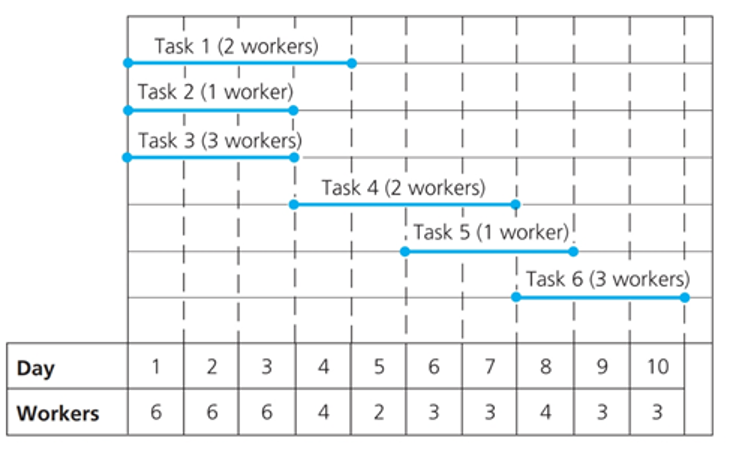

Reference the preliminary project schedule (see figure below), answer the following questions.

Reference the preliminary project schedule (see figure below), answer the following questions.

NOTE: The critical path of this project comprises of Tasks 3, 4 and 6.

Question 1: Perform resource leveling for this project (without delaying the project). How many workers would you need?

Question 2: Using the smallest-slack-first rule, perform a resource-constrained leveling of the project for a scenario where only three workers are available to work on this project. What is the new project completion date?

Instructions: You can copy/paste the grid multiple times to document each iteration of the resource leveling heuristic. Add rows and columns as needed. You are free to use another format to do this assignment, if you like. Crtitical Path is 3-4-6

Crtitical Path is 3-4-6
TASK 1 2 2 2 2
TASK 2 1 1 1
TASK 3 3 3 3
TASK 4 2 2 2 2
TASK 5 1 1 1
TASK 6 3 3 3
Day 1 2 3 4 5 6 7 8 9 10
Workers 6 6 6 4 2 3 3 4 3 3

Instructions: You can copy/paste the grid multiple times to document each iteration of the resource leveling heuristic. Add rows and columns as needed. You are free to use another format to do this assignment, if you like.

Crtitical Path is 3-4-6
Slack
TASK 1 2 2 2 2 6
TASK 2 1 1 1 7
TASK 3 3 3 3 0 Because it is a critical task
TASK 4 2 2 2 2 0 Because it is a critical task
TASK 5 1 1 1 2
TASK 6 3 3 3 0 Because it is a critical task
Day 1 2 3 4 5 6 7 8 9 10
Workers 6 6 6 4 2 3 3 4 3 3

\begin{tabular}{|c|c|c|c|c|c|c|c|c|c|c|} \hline & & 1 & vor & & & & & & & T \\ \hline & Task & (1 & orke & & & & & & & \\ \hline & Task & (3 & orke & & & & & | & & 1 \\ \hline & & & & & & & & & & 1 \\ \hline & & & & & 4 & wor & & & & 1 \\ \hline & & & & & & Tas & (1 & orker & & | \\ \hline & & & & & & & & Task & (3 & grkers) \\ \hline & & & & & & & & & & \\ \hline Day & 1 & 2 & 3 & 4 & 5 & 6 & 7 & 8 & 9 & 10 \\ \hline Workers & 6 & 6 & 6 & 4 & 2 & 3 & 3 & 4 & 3 & 3 \\ \hline \end{tabular}

Step by Step Solution

There are 3 Steps involved in it

1 Expert Approved Answer
Step: 1 Unlock blur-text-image
Question Has Been Solved by an Expert!

Get step-by-step solutions from verified subject matter experts

Step: 2 Unlock
Step: 3 Unlock

Students Have Also Explored These Related General Management Questions!
