Question: REQUIRED Based on the information below, we would like you to build a project schedule and resource chart . You can use a PERT/Network Diagram
REQUIRED
Based on the information below, we would like you to build a project schedule and resource chart.
You can use a PERT/Network Diagram approach, create a Gantt chart in Excel, or use some other piece of planning/scheduling software (for example, MS Project, Primavera, or another of your choice).
This schedule must contain the following information:
An appropriate WBS Different activity types Logic-driven start and finish dates Highlight the Critical Path Either a Resource Histogram or Resource Spreadsheet
Project Goal:
Your current bathroom is unsuitable due to a lack of insulation. This makes it very cold. You want to ensure that the bathroom is warm, and also re-decorated after any building work is completed
Project Objectives:
To strap and insulate the walls To decorate the bathroom
Project Dates:
Start Date: 4 June 2021
End Date: ?
Calendar/Working hours:
Working Hours are Monday - Friday, 0900 - 1700

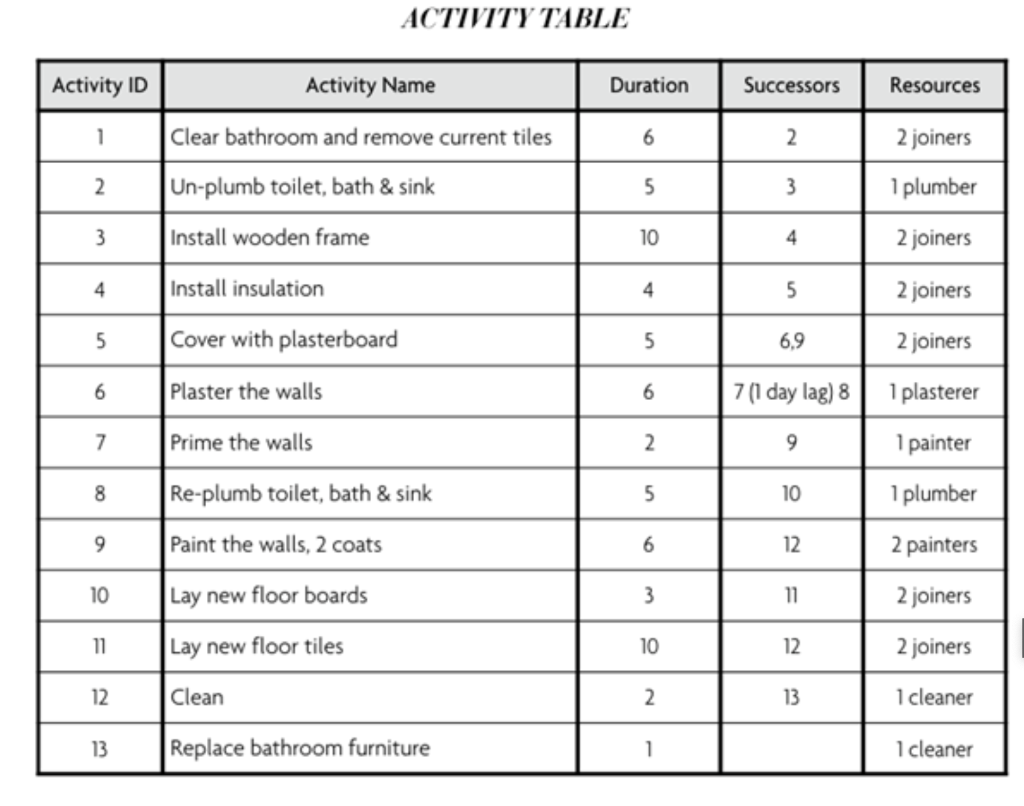

Following is the Activity Table
