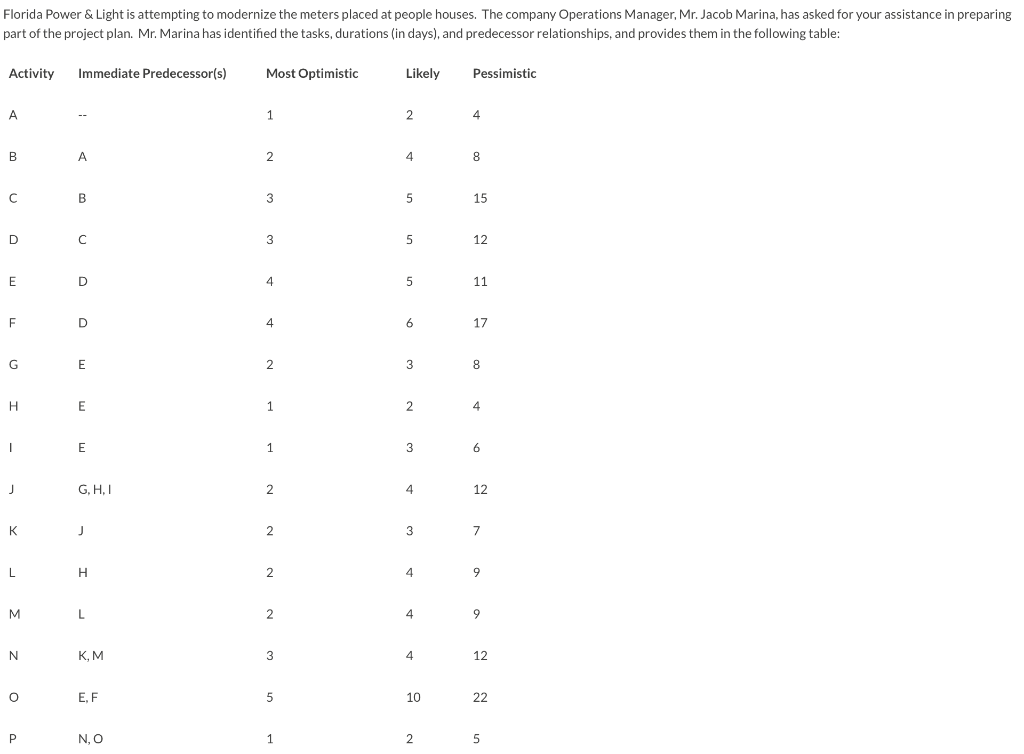

Question: Required: Draw the Activity on Node (AON) network. Determine the expected completion time and variance for each activity. Determine the total project completion time and

Required:
- Draw the Activity on Node (AON) network.
- Determine the expected completion time and variance for each activity.
- Determine the total project completion time and activities along the critical path for the project.
- Determine ES, EF, LS, LF, and slack for each activity.
- Identify which activities are candidates for crashing, and explain why.
