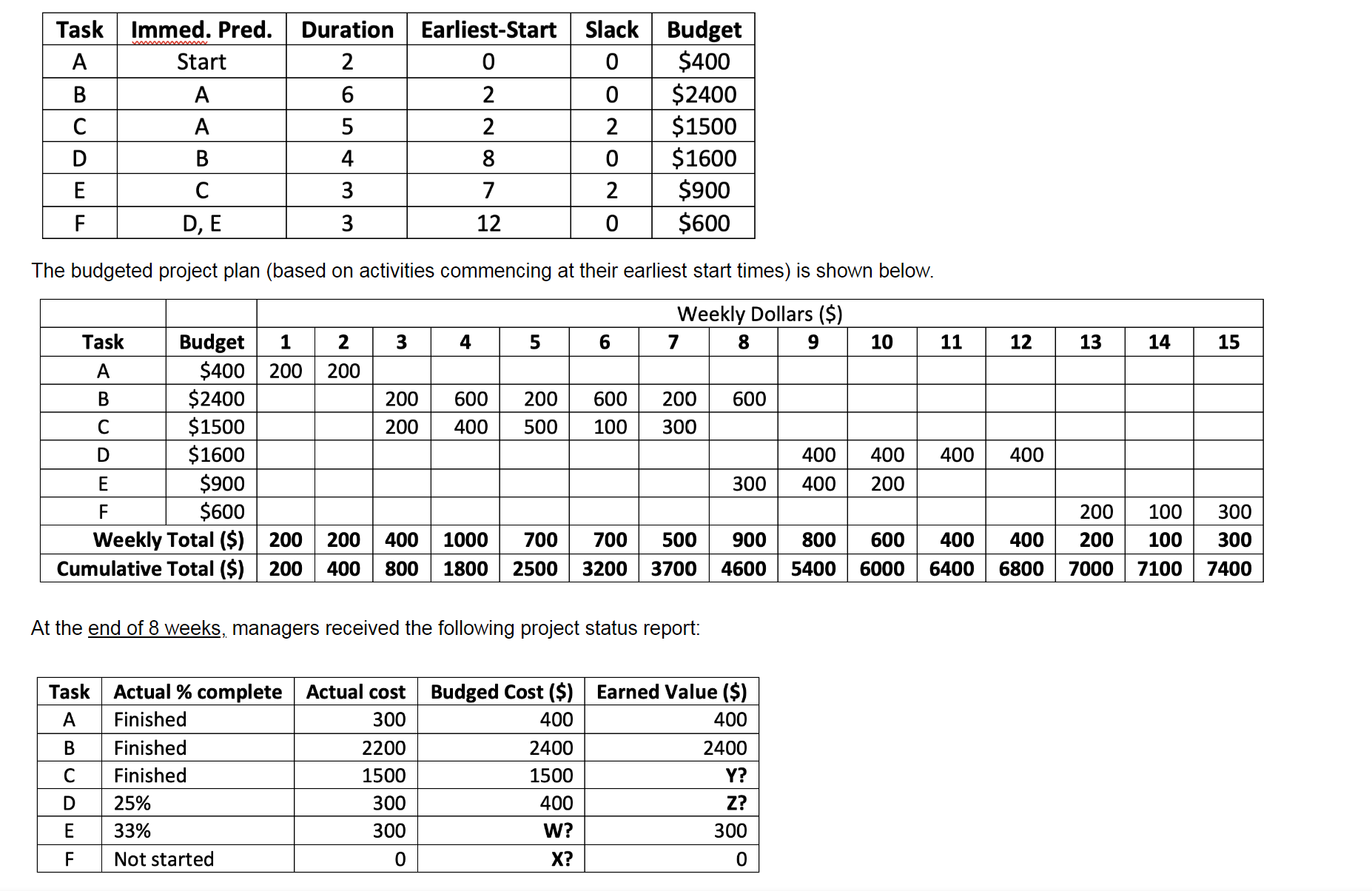

Question: The budgeted project plan ( based on activities commencing at their earliest start times ) is shown below. At the end of 8 weeks, managers
The budgeted project plan based on activities commencing at their earliest start times is shown below.
At the end of weeks, managers received the following project status report:
