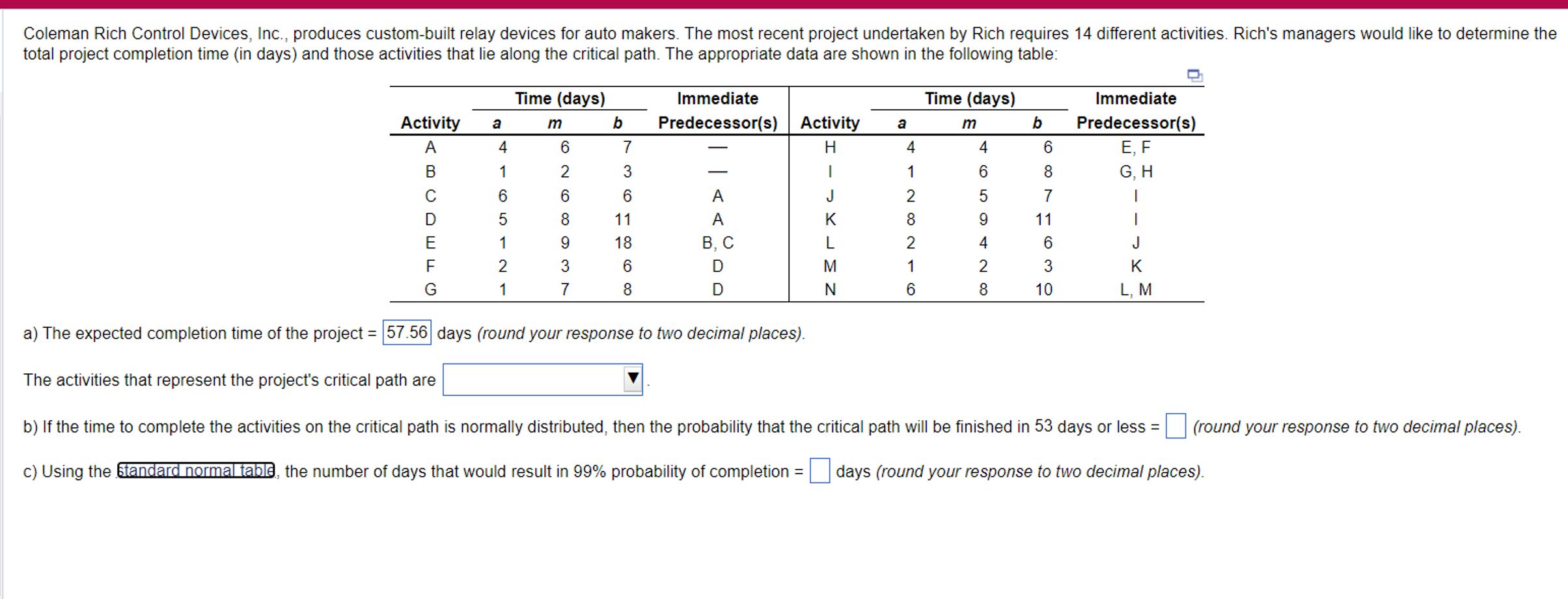

Question: total project completion time ( in days ) and those activities that lie along the critical path. The appropriate data are shown in the following

total project completion time (in days) and those activities that lie along the critical path. The appropriate data are shown in the following table:
\table[[,Time (days),Immediate,,Time (days),Immediate],[Activity,a,m,b,Predecessor(s),Activity,a,m,b,Predecessor(s)],[A,4,6,7,-,H,4,4,6,E, F],[B,1,2,3,-,I,1,6,8,G, H],[C,6,6,6,A,J,2,5,7,I],[D,5,8,11,A,K,8,9,11,I],[E,1,9,18,B, C,L,2,4,6,J],[F,2,3,6,D,M,1,2,3,K],[G,1,7,8,D,N,6,8,10,L, M]]
a) The expected completion time of the project =57.56 days (round your response to two decimal places).
The activities that represent the project's critical path are
c) Using the tandard normal table, the number of days that would result in 99% probability of completion = days (round your response to two decimal places).
 total project completion time (in days) and those activities that lie

Step by Step Solution

There are 3 Steps involved in it

1 Expert Approved Answer
Step: 1 Unlock blur-text-image
Question Has Been Solved by an Expert!

Get step-by-step solutions from verified subject matter experts

Step: 2 Unlock
Step: 3 Unlock

Students Have Also Explored These Related General Management Questions!
