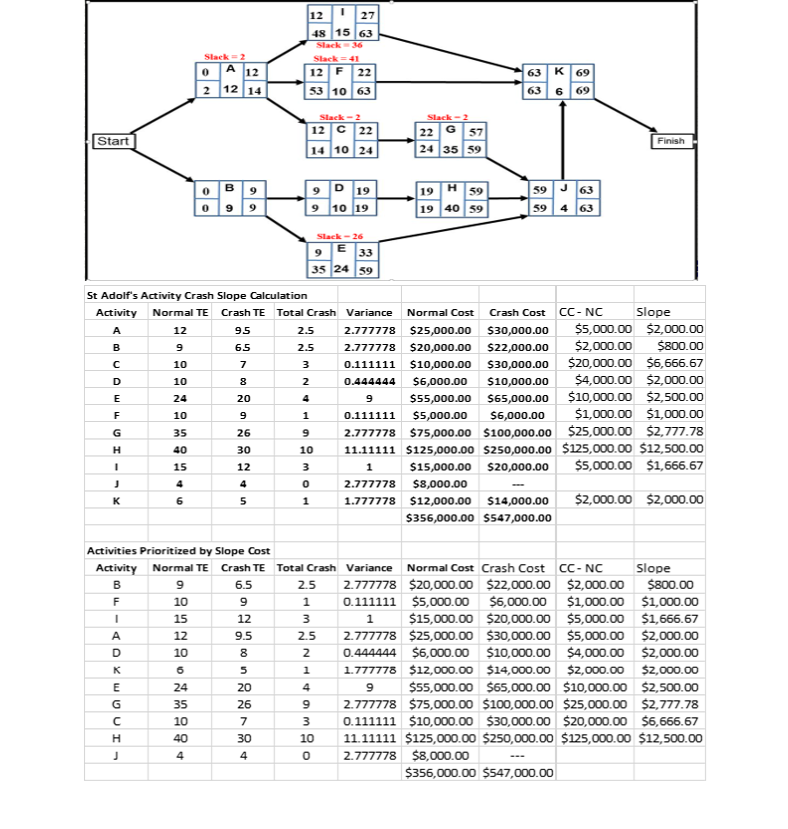

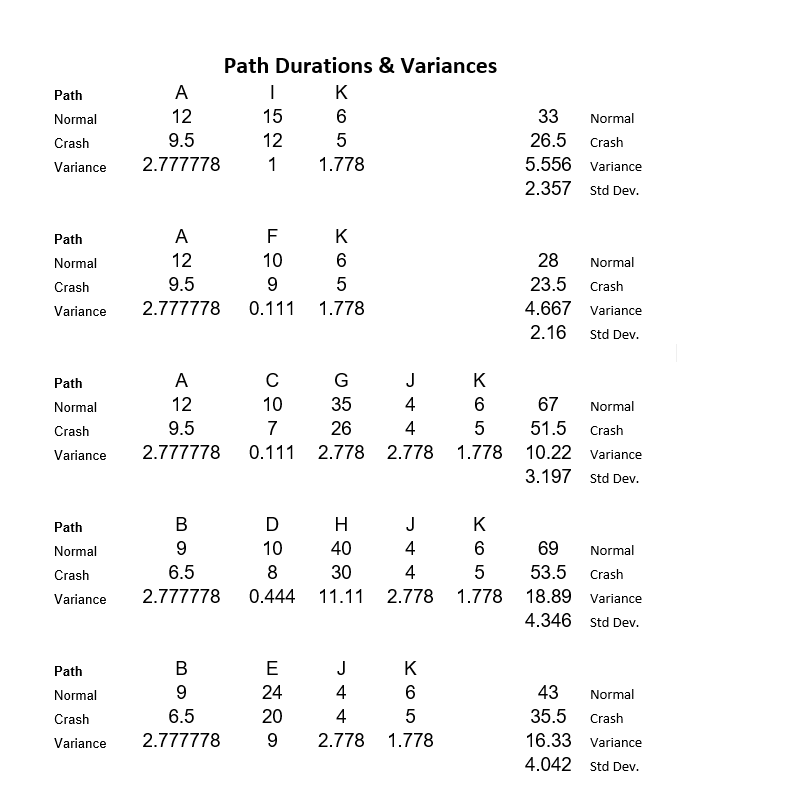

Question: Use the information attached to develop a strategy to bid a 65 week completion time with at-least a 90% probability of being completed on-time. Your
Use the information attached to develop a strategy to bid a 65 week completion time with at-least a 90% probability of being completed on-time. Your final report should include:
- A list of activities that you will crash and how much you will crash them.
- The expected completion time for project given the activity crash times
- Your calculations showing the probability that the project will be completed in 65 weeks.
- The revised cost of the project based on the crashed activities.


Slack = 2 1227 48 15 63 Slack36 Slack = 41 12F 22 53 10 63 A 12 2 12 14 63 K 69 63 669 Start Stack - 2 12 C 22 14 10 24 Slack-2 22 57 24 35 59 Finish 0 B 9 0 9 9 90 19 9 10 19 19 H 59 19 40 59 59 - 63 594 63 Slack-26 9 E 33 35 24 59 24 St Adolf's Activity Crash Slope Calculation Activity Normal TE Crash TE Total Crash Variance Normal Cost Crash Cost CC-NC Slope 12 95 2.5 2.777778 $25,000.00 $30,000.00 $5,000.00 $2,000.00 B 65 2.5 2.777778 $20,000.00 $22,000.00 $2,000.00 $800.00 c 10 7 3 0.111111 $10,000.00 $30,000.00 $20,000.00 $6,666.67 D 10 2 0.444444 $6,000.00 $10,000.00 $4,000.00 $2,000.00 E 20 9 $55,000.00 $65,000.00 $10,000.00 $2,500.00 0.111111 $5,000.00 $6,000.00 $1,000.00 $1,000.00 G 35 9 2.777778 $75,000.00 $100,000.00 $25,000.00 $2,777.78 H 30 10 11.11111 $125,000.00 $250,000.00 $125,000.00 $12,500.00 3 1 $15,000.00 $20,000.00 $5,000.00 $1,666.67 J 2.777778 $8,000.00 K 6 1 1.777778 $12,000.00 $14,000.00 $2,000.00 $2,000.00 $356,000.00 $547,000.00 Tim 10 1 G 26 00 So Ni 40 1 15 no 4 9 10 15 12 Activities Prioritized by Slope Cost Activity Normal TE Crash Te Total Crash Variance Normal Cost Crash Cost CC-NC Slope B 9 6.5 2.5 2.777778 $20,000.00 $22,000.00 $2,000.00 $800.00 F 1 0.111111 $5,000.00 $6,000.00 $1,000.00 $1,000.00 12 1 $15,000.00 $20,000.00 $5,000.00 $1,666.67 9.5 2.5 2.777778 $25,000.00 $30,000.00 $5,000.00 $2,000.00 D 2 0.444444 $6,000.00 $10,000.00 $4,000.00 $2,000.00 1.777778 $12,000.00 $14,000.00 $2,000.00 $2,000.00 E 20 9 $55,000.00 $65,000.00 $10,000.00 $2,500.00 2.777778 $75,000.00 $100,000.00 $25,000.00 $2,777.78 10 3 0.111111 $10,000.00 $30,000.00 $20,000.00 $6,666.67 H 40 30 10 11.11111 $125,000.00 $250,000.00 $125,000.00 $12,500.00 J 2.777778 $8,000.00 $356,000.00 $547,000.00 Inam 70D - 0 8 5 10 6 24 35 26 7 4 4 Path Normal Crash Variance Path Durations & Variances A 1 12 15 6 9.5 12 5 2.777778 1 1.778 33 Normal 26.5 Crash 5.556 Variance 2.357 Std Dev. Path Normal Crash Variance A 12 9.5 2.777778 F 10 9 0.111 K 6 5 1.778 28 Normal 23.5 Crash 4.667 Variance 2.16 Std Dev. Path Normal A 12 9.5 2.777778 10 7 0.111 G J 35 4 26 4 2.778 2.778 K 6 5 1.778 Crash 67 Normal 51.5 Crash 10.22 Variance 3.197 Std Dev. Variance Path . 40 Normal Crash Variance B 9 6.5 2.777778 D 10 8 0.444 J 4 4 2.778 K 6 5 1.778 Normal Crash 30 69 53.5 18.89 4.346 11.11 Variance Std Dev. Path Normal B 9 6.5 2.777778 E 24 20 9 J K 4 6 4 5 2.778 1.778 Crash 43 Normal 35.5 Crash 16.33 Variance 4.042 Std Dev. Variance
