Question: Use the tabs in this spreadsheet to complete this assignment. Task 1 - Create a Baseline Budget for this project ( use Tab: Task 1

Use the tabs in this spreadsheet to complete this assignment.
Task 1- Create a Baseline Budget for this project (use Tab: Task 1- Baseline Budget)(25 Points)
Task 2- The project plan gets revised and you now have a new baseline budget given to you (Tab: Revised Budget) go to this worksheet and complete all the entries the EVM tables given for each update. Then, at the end period 8, give an assessment on project's progress in terms of its budget and schedule, if the project progress continues in this way. (50 Points) The CRM PROJECT

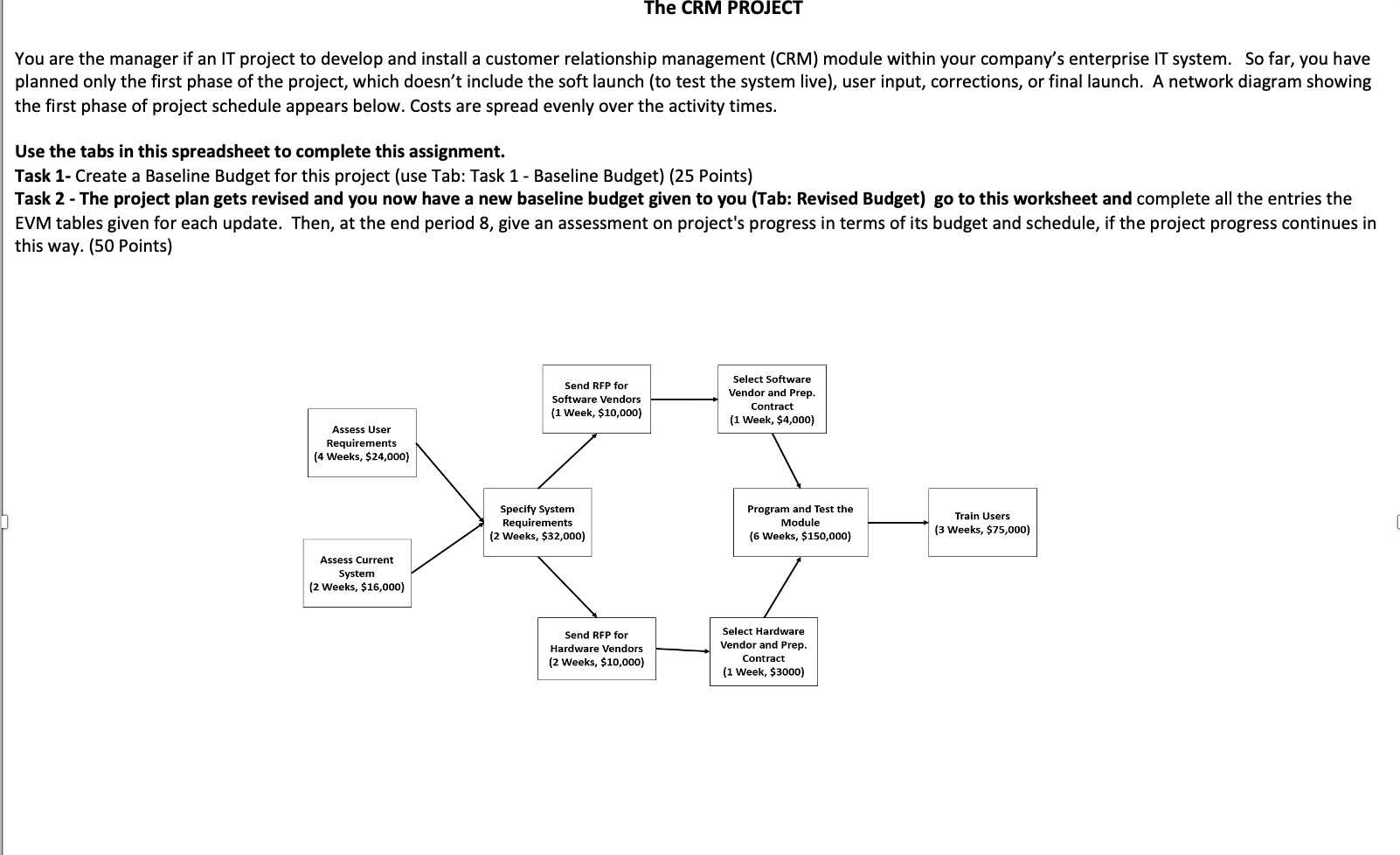

You are the manager if an IT project to develop and install a customer relationship management (CRM) module within your company's enterprise IT system. So far, you have planned only the first phase of the project, which doesn't include the soft launch (to test the system live), user input, corrections, or final launch. A network diagram showing the first phase of project schedule appears below. Costs are spread evenly over the activity times.
Use the tabs in this spreadsheet to complete this assignment.
Task 1- Create a Baseline Budget for this project (use Tab: Task 1- Baseline Budget)(25 Points)
Task 2- The project plan gets revised and you now have a new baseline budget given to you (Tab: Revised Budget) go to this worksheet and complete all the entries the EVM tables given for each update. Then, at the end period 8, give an assessment on project's progress in terms of its budget and schedule, if the project progress continues in this way. (50 Points) sk 1: Complete the baseline budget for this project. Assume that the budget for an activity is used uniformly during duration.
\begin{tabular}{|c|c|c|c|c|c|c|c|c|c|c|c|c|c|c|c|c|c|c|c|c|c|c|c|c|c|c|c|c|}
\hline ,ject: CRM & Budget & & & 23 & & 4-5 & 5 & 6 & & 8 & 10 & 10 & 112 & 13 & 13|4 & 1415 & 1516 & 6-17 & 718 & 819 & 1920 & 2021 & 2122 & 23 & 34 & 425 & 25 & \(26-27\)\\
\hline 3ess User Requirements & \$24,000 & & & & & & & & & & & & & & & & & & & & & & & & & & & \\
\hline sess Curent System & \$16,000 & & & & & & & & & & & & & & & & & & & & & & & & & & & \\
\hline exify System Requirements & \$32,000 & & & & & & & & & & & & & & & & & & & & & & & & & & & \\
\hline Ad RFP for Soffware Vendors & \$10,000 & & & & & & & & & & & & & & & & & & & & & & & & & & & \\
\hline id RFP for Hardware Vendors & \$10,000 & & & & & & & & & & & & & & & & & & & & & & & & & & & \\
\hline ect Soffware Vendor & \$4,000 & & & & & & & & & & & & & & & & & & & & & & & & & & & \\
\hline ect Hardware Vendor & \$3,000 & & & & & & & & & & & & & & & & & & & & & & & & & & & \\
\hline gram and Test the Module & \$150,000 & & & & & & & & & & & & & & & & & & & & & & & & & & & \\
\hline in Users & \$75,000 & & & & & & & & & & & & & & & & & & & & & & & & & & & \\
\hline mulative & \$324,000 & & & & & & & & & & & & & & & & & & & & & & & & & & & \\
\hline
\end{tabular}
What is the budget at completion for this project?
\$324,000
What is the expected completion time for this project? \begin{tabular}{|c|c|c|c|c|c|c|c|c|c|c|c|c|c|c|c|c|c|c|c|c|c|c|c|}
\hline Project CRM & Budget & & 2 & 3 & 4 & & 6 & & & & 10 & 11 & 12 & 13 & 14 & 15 & 516 & 17 & 18 & 8-19 & 1920 & 21 & 122\\
\hline Assess User Requirements & \$20,000 & \$5,000 & \$5,000 & \$5,000 & \$5,000 & & & & & & & & & & & & & & & & & & \\
\hline Assess Current System & \$30,000 & \$10,000 & \$10,000 & \$10,000 & & & & & & & & & & & & & & & & & & & \\
\hline Specify System Requirements & \$30,000 & & & & & \$15,000 & \$15,000 & & & & & & & & & & & & & & & & \\
\hline Send REP for Software Vendors & \$15,000 & & & & & & & \$10,000 & \$2,500 & 0\$2,500 & & & & & & & & & & & & & \\
\hline Send REP for Hardware Vendors & \$15,000 & & & & & & & \$10,000 & \$5,000 & & & & & & & & & & & & & & \\
\hline Select Software Vendor & \$7,000 & & & & & & & & & & 57,000 & & & & & & & & & & & & \\
\hline Select Hardware Vendor & \$8,000 & & & & & & & & & \$8,000 & & & & & & & & & & & & & \\
\hline Program and Test the Module & \$200,000 & & & & & & & & & & & \$25,000 & \$25,000 & \$25,000 & \$25,000 & \$25,000 & \$25,000 & \$25,000 & \$25,000 & & & & \\
\hline train Users & \$100,000 & & & & & & & & & & & & & & & & & & & \$25,000 & 0\$25,000 & \$25,000 & \$25,000\\
\hline Cumulative & \$425,000 & & & & & & & & & & & & & & & & & & & & & & \\
\hline
\end{tabular}
Week 4
\begin{tabular}{|l|r|l|l|l|l|l|}
\hline Activity & \% Complete & AC & EV & PV & SV & CV \\
\hline Assess User Requirements & \(100\%\) & \(\$ 20,000\) & & & & \\
\hline Assess Current System & \(100\%\) & \(\$ 32,000\) & & & & \\
\hline Cumulative & & & & & & \\
\hline
\end{tabular}
Week 8
\begin{tabular}{|l|r|l|l|l|l|l|}
\hline Activity & \% Complete & AC & EV & PV & SV & CV \\
\hline Asses User Requirements & \(100\%\) & \(\$ 20,000\) & & & & \\
\hline Asses Current System & \(100\%\) & \(\$ 32,000\) & & & & \\
\hline Specify System Requirements & \(100\%\) & \(\$ 18,000\) & & & & \\
\hline Send ReP for Software Vendors & \(75\%\) & \(\$ 13,000\) & & & & \\
\hline Send ReP for Hardware Vendors & \(100\%\) & \(\$ 15,000\) & & & & \\
\hline Cumulative & & & & & & \\
\hline
\end{tabular}
What is your overall assessment at this period (Week 8), does it appear that the project is likely to finish on-time and on-budget? Why or why not? Explain your assessment (your response should not exceed the space provided here).
Use the tabs in this spreadsheet to complete this

Step by Step Solution

There are 3 Steps involved in it

1 Expert Approved Answer
Step: 1 Unlock blur-text-image
Question Has Been Solved by an Expert!

Get step-by-step solutions from verified subject matter experts

Step: 2 Unlock
Step: 3 Unlock

Students Have Also Explored These Related General Management Questions!
