Question: Using critical path method, identify the critical activities and prepare a report determining the earliest and latest activity times, activity slack, critical path, duration for
Using critical path method, identify the critical activities and prepare a report determining the earliest and latest activity times, activity slack, critical path, duration for the project and crash the project.

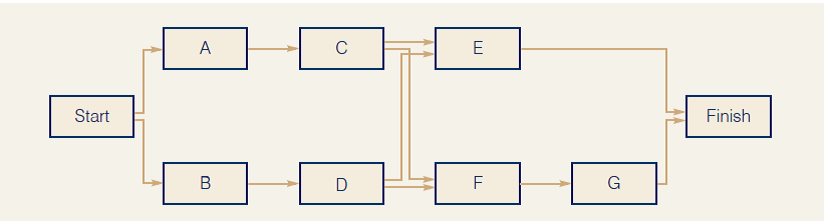

Given the following project network, with the time estimated in weeks, answer the following questions:

| Activity | A | B | C | D | E | F | G |
| Time | 4 | 7 | 2 | 5 | 6 | 5 | 4 |
The crashing data of the project is as given below:
| Activity | Time in weeks | Cost in SAR | ||
| Normal | Crash | Normal | Crash | |
| A | 4 | 2 | 5000 | 7500 |
| B | 7 | 4 | 4500 | 6575 |
| C | 2 | 1 | 3000 | 3500 |
| D | 5 | 2 | 2750 | 3250 |
| E | 6 | 3 | 4250 | 5250 |
| F | 5 | 4 | 3750 | 4200 |
| G | 4 | 2 | 2575 | 3500 |
- What are the critical path activities? What is the expected time to complete the project? (5 marks)
- What is the total project cost using the normal times? (1 marks)
c.Crash the project to 18 weeks. What is the cost after crashing
A E Start Finish B D F GStep by Step Solution
There are 3 Steps involved in it
