Question: Using the information provided in the table, the network diagram and the project completion time = 24 weeks, calculate the minimum time for completing the

Using the information provided in the table, the network diagram and the project completion time = 24 weeks, calculate the minimum time for completing the project possible.

Activity

Normal Time (weeks)

Normal Cost ($)

Crash Time (weeks)

Crash Cost ($)

Maximum weeks Reduced

Crash Cost per Week ($)

A

2 500 1 900 1 400

B

4 600 3 700 1 100

C

6 800 3 1,300 3 167

D

6 1,500 4 2,150 2 325

E

6 1,750 4 2,250 2 250

F

5 1,200 5 1,200 0 0

G

7 1,500 5 1,800 2 150

H

3 500 3 500 0 0

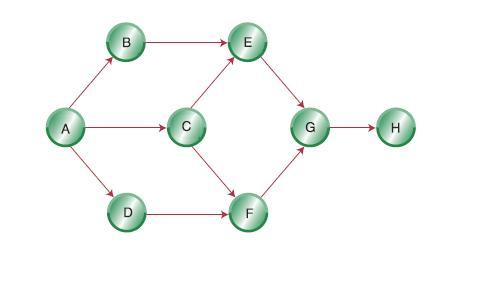

AON network diagram: Using the information provided in the table, the

Minimum project completion time = enter minimum project completion time in weeks

A B E F H

Step by Step Solution

There are 3 Steps involved in it

1 Expert Approved Answer
Step: 1 Unlock blur-text-image
Question Has Been Solved by an Expert!

Get step-by-step solutions from verified subject matter experts

Step: 2 Unlock
Step: 3 Unlock

Students Have Also Explored These Related General Management Questions!
