Question: Using the information provided in the table, the network diagram and the project completion time = 25 weeks, reduce the completion time of the project

Using the information provided in the table, the network diagram and the project completion time = 25 weeks, reduce the completion time of the project by 5 weeks in the most economical way.

Activity

Normal Time (weeks)

Normal Cost ($)

Crash Time (weeks)

Crash Cost ($)

Maximum Weeks Reduced

Crash Cost per Week ($)

A

3 500 2 900 1 400

B

4 650 3 740 1 90

C

6 850 3 1,345 3 165

D

6 1,500 4 2,180 2 340

E

6 1,900 4 2,420 2 260

F

5 200 5 200 0 0

G

7 1,450 5 1,750 2 150

H

3 500 3 500 0 0

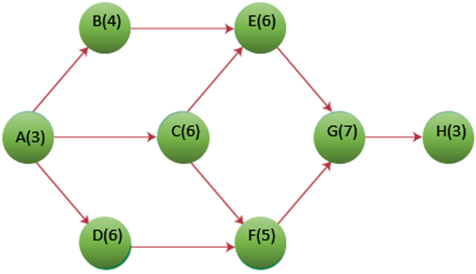

AON network diagram Using the information provided in the table, the

(If there is no amount for a box enter 0. All boxes must be filled.) Reduce A by enter a number of weeks week(s), B by enter a number of weeks week(s), C by enter a number of weeks week(s), D by enter a number of weeks week(s), E by enter a number of weeks week(s), F by enter a number of weeks week(s), G by enter a number of weeks week(s), H by enter a number of weeks week(s). Total additional cost is $enter total additional cost in dollars .

A(3) B(4) D(6) C(6) E(6) F(5) G(7) H(3)

Step by Step Solution

There are 3 Steps involved in it

1 Expert Approved Answer
Step: 1 Unlock blur-text-image
Question Has Been Solved by an Expert!

Get step-by-step solutions from verified subject matter experts

Step: 2 Unlock
Step: 3 Unlock

Students Have Also Explored These Related General Management Questions!
