Question: What is the critical path(s) and the completion time for the project? A. Path A-B-F, 19 days B. Path A-B-F, 20 days C. Path C-D-E-F,

What is the critical path(s) and the completion

  1. What is the critical path(s) and the completion time for the project?

A. Path A-B-F, 19 days

B. Path A-B-F, 20 days

C. Path C-D-E-F, 19 days

D. Path C-D-E-F, 20 days

E. Paths A-B-F and C-D-E-F, 20 days

  1. If you crash this project to reduce the total time by one day as long as the crashing cost is less than $1,000, which activity (activities) should you crash?

A. Activity A

B. Activity B

C. Activity C

D. Activity D

E. Activity E

  1. If you crash this project to reduce the total time by a second day as long as the crashing cost is less than $1,000, which activity (activities) should you crash?

A. None

B. Activity B

C. Activity E

D. Activities B and C

E. Activities B and E

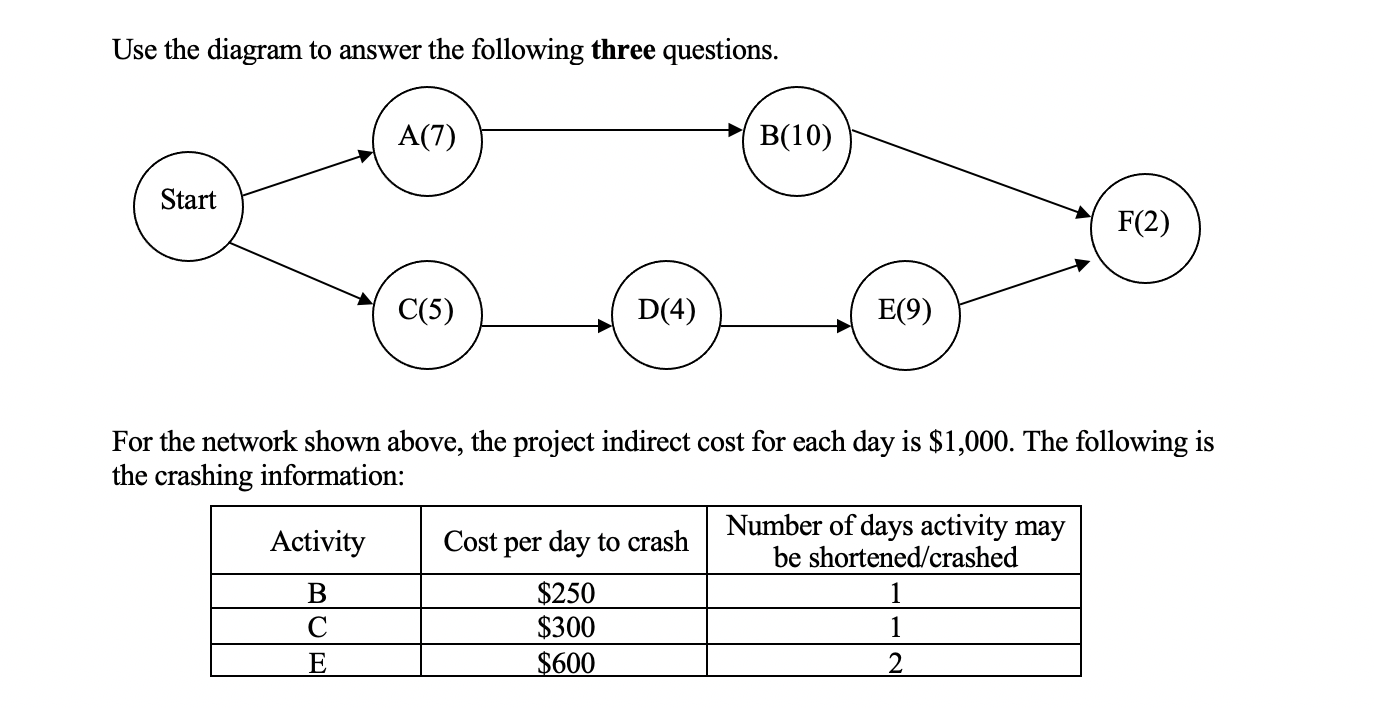

Use the diagram to answer the following three questions. A(7) B(10) Start F(2) C(5) D(4) E(9) For the network shown above, the project indirect cost for each day is $1,000. The following is the crashing information: Number of days activity may Activity Cost per day to crash be shortened/crashed $250 $300 $600 2 B 1 E

Step by Step Solution

There are 3 Steps involved in it

1 Expert Approved Answer
Step: 1 Unlock blur-text-image
Question Has Been Solved by an Expert!

Get step-by-step solutions from verified subject matter experts

Step: 2 Unlock
Step: 3 Unlock

Students Have Also Explored These Related General Management Questions!
