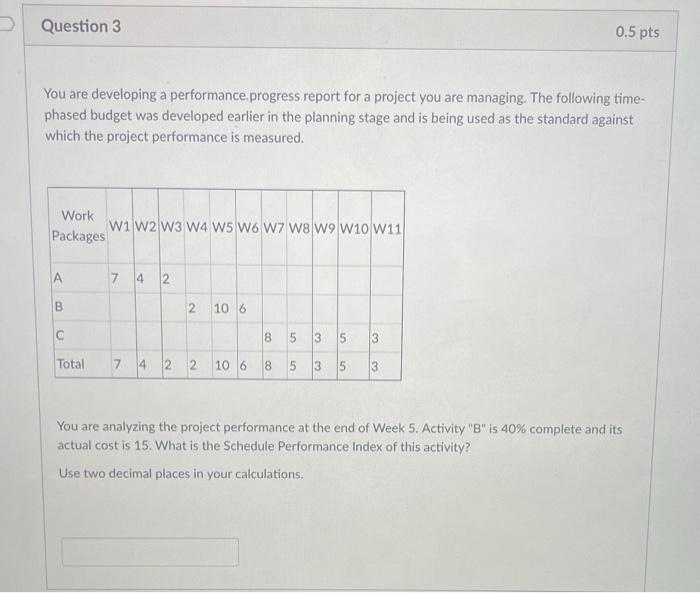

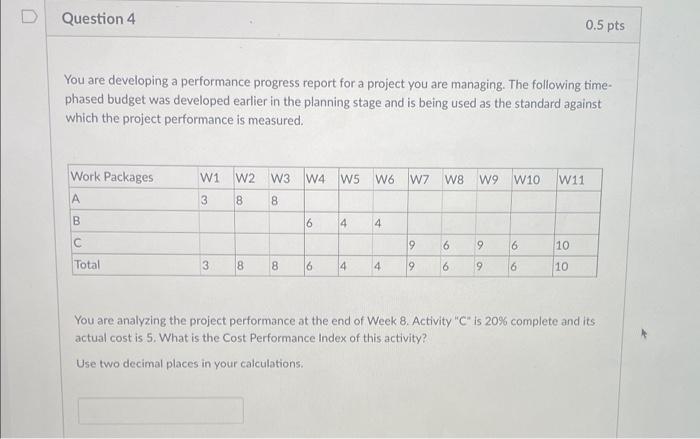

Question: You are developing a performance progress report for a project you are managing. The following timephased budget was developed earlier in the planning stage and

You are developing a performance progress report for a project you are managing. The following timephased budget was developed earlier in the planning stage and is being used as the standard against which the project performance is measured. At the end of Week 6, Activity " B " is 90% complete and its actual cost is 15 . What is the Planned Value of this activity? Use two decimal places in your calculations. You are developing a performance.progress report for a project you are managing. The following timephased budget was developed earlier in the planning stage and is being used as the standard against which the project performance is measured. You are analyzing the project performance at the end of Week 5. Activity "B" is 40% complete and its actual cost is 15 . What is the Schedule Performance Index of this activity? Use two decimal places in your calculations. You are developing a performance progress report for a project you are managing. The following timephased budget was developed earlier in the planning stage and is being used as the standard against which the project performance is measured. You are analyzing the project performance at the end of Week 8. Activity " C " is 20% complete and its actual cost is 5. What is the Cost Performance Index of this activity? Use two decimal places in your calculations
Step by Step Solution
There are 3 Steps involved in it
Get step-by-step solutions from verified subject matter experts
