Question: You may need to use the appropriate technology to answer this question. Mueller & Associates is a urban planning firm that is designing a new

You may need to use the appropriate technology to answer this question.
Mueller & Associates is a urban planning firm that is designing a new public park in an Omaha suburb. Coordination of the architect and subcontractors will require a major effort to meet the 45-week completion date requested by the owner. The Mueller project manager prepared the following project network.

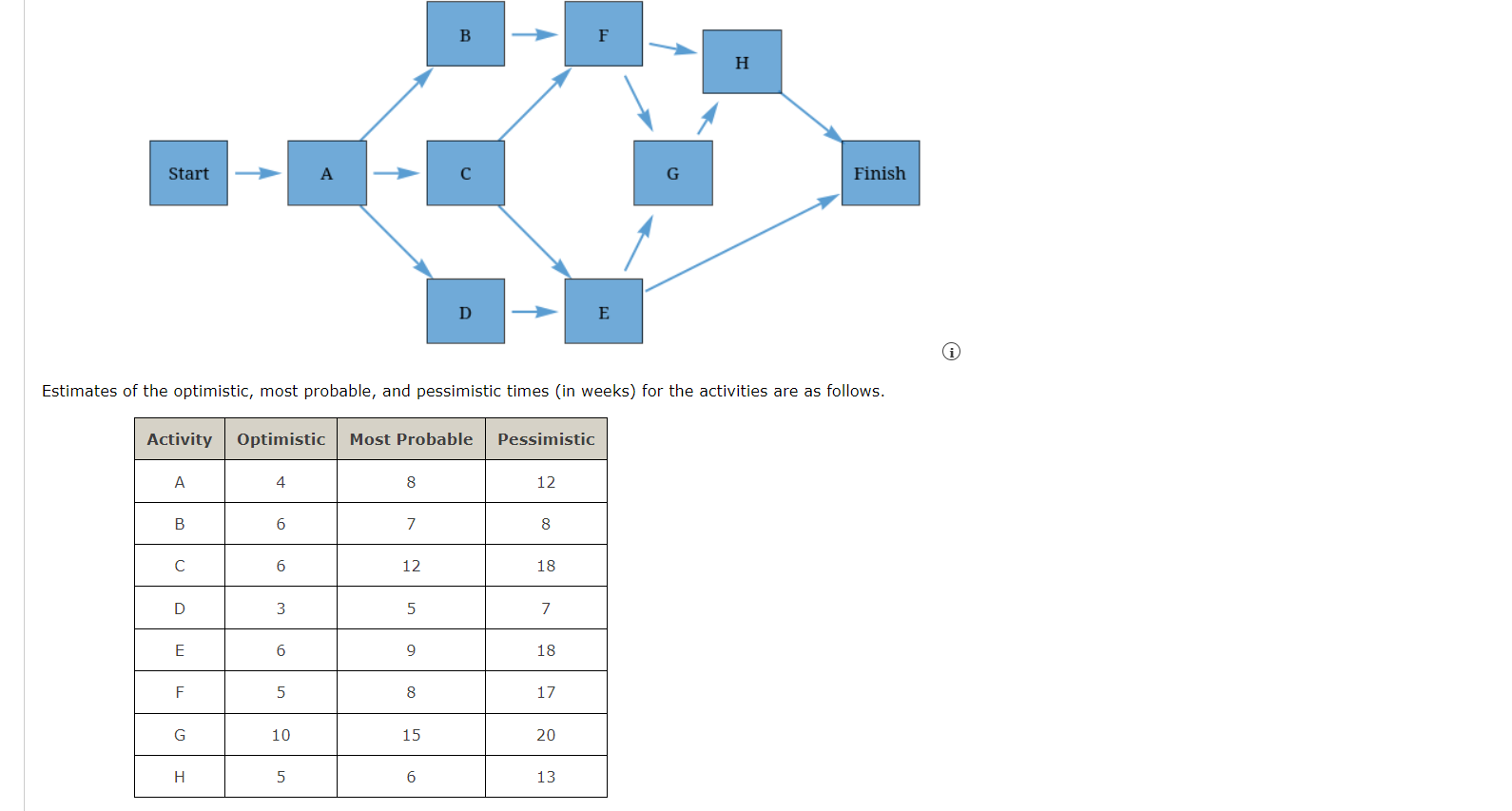

A project network with 10 activities and 14 directed arcs is shown.
Activity Start is connected to activity A.
Activity A is connected to activity B, to activity C, and to activity D.
Activity B is connected to activity F.
Activity C is connected to activity E and to activity F.
Activity D is connected to activity E.
Activity E is connected to activity G and to activity Finish.
Activity F is connected to activity G and to activity H.
Activity G is connected to activity H.
Activity H is connected to activity Finish.
Activity Finish has no arcs directed to other activities.
Estimates of the optimistic, most probable, and pessimistic times (in weeks) for the activities are as follows.
Activity Optimistic Most Probable Pessimistic
A 4812
B 678
C 61218
D 357
E 6918
F 5817
G 101520
H 5613
(a)
Find the critical path. (Enter your answers as a comma-separated list.)
Correct: Your answer is correct.
(b)
What is the expected project completion time (in weeks)?
52
Correct: Your answer is correct.
weeks
(c)
Based only on the critical path, what is the estimated probability the project can be completed in 45 weeks as requested by the owner? (Round your answer to four decimal places.)
0.49
Incorrect: Your answer is incorrect.
(d)
Based only on the critical path, what is the estimated probability the building project could run more than 3 months late? Use 58 weeks for this calculation. (Round your answer to four decimal places.)
.4168
Incorrect: Your answer is incorrect.
(e)
What should the construction company tell the owner? (Enter your free-form answer using as many characters as necessary.)(i)
Estimates of the optimistic, most probable, and pessimistic times (in weeks) for the activities are as follows.
\table[[Activity,Optimistic,Most Probable,Pessimistic],[A,4,8,12],[B,6,7,8],[C,6,12,18],[D,3,5,7],[E,6,9,18],[F,5,8,17],[G,10,15,20],[H,5,6,13]]
 You may need to use the appropriate technology to answer this

Step by Step Solution

There are 3 Steps involved in it

1 Expert Approved Answer
Step: 1 Unlock blur-text-image
Question Has Been Solved by an Expert!

Get step-by-step solutions from verified subject matter experts

Step: 2 Unlock
Step: 3 Unlock

Students Have Also Explored These Related General Management Questions!
