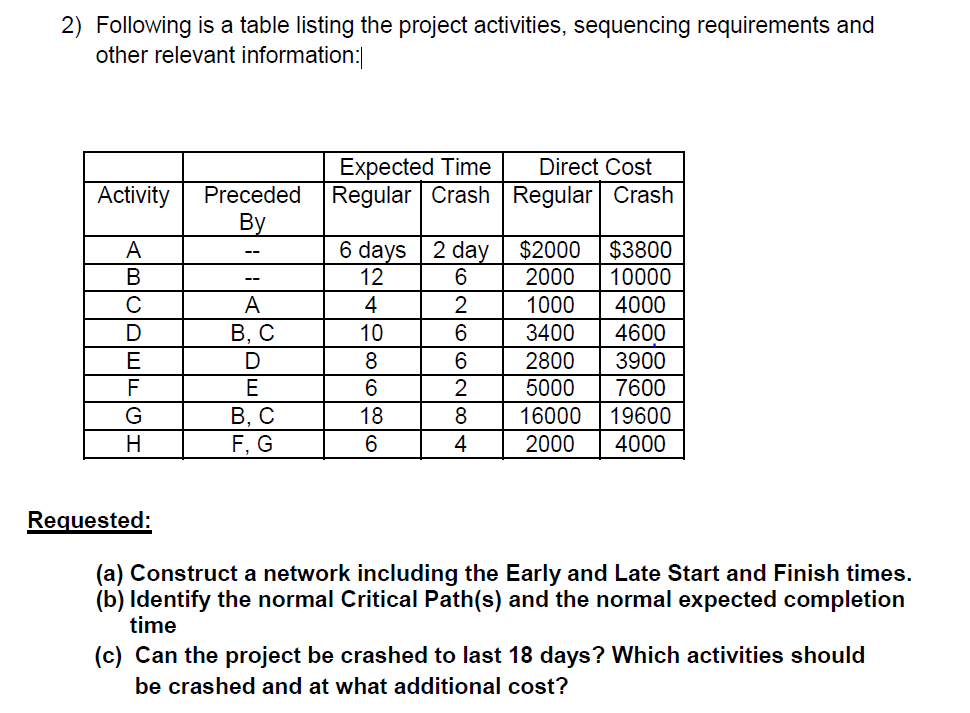

2) Following is a table listing the project activities, sequencing requirements and other relevant information:| equested: (a) Construct a network including the Early and Late Start and Finish times. (b) Identify the normal Critical Path(s) and the normal expected completion time (c) Can the project be crashed to last 18 days? Which activities should be crashed and at what additional cost
