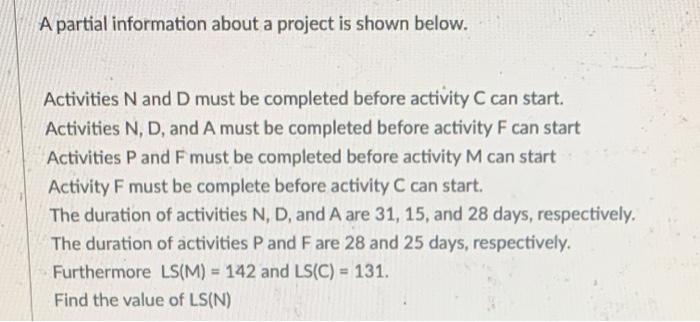

Question: A partial information about a project is shown below. Activities N and D must be completed before activity C can start. Activities N, D, and

A partial information about a project is shown
A partial information about a project is shown below. Activities N and D must be completed before activity C can start. Activities N, D, and A must be completed before activity F can start Activities P and F must be completed before activity M can start Activity F must be complete before activity C can start. The duration of activities N, D, and A are 31, 15, and 28 days, respectively. The duration of activities P and Fare 28 and 25 days, respectively, Furthermore LS(M) = 142 and LS(C) = 131. Find the value of LS(N)
