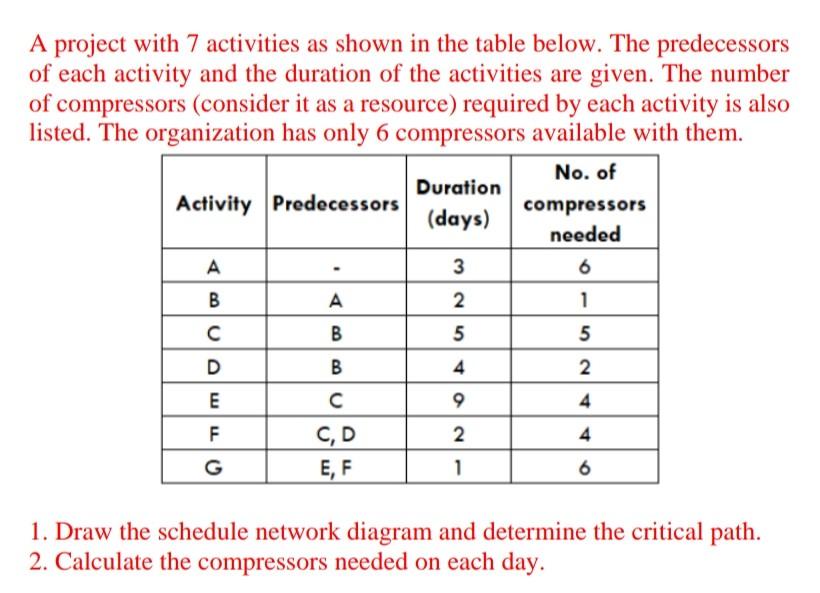

Question: A project with 7 activities as shown in the table below. The predecessors of each activity and the duration of the activities are given. The

A project with 7 activities as shown in the table

A project with 7 activities as shown in the table below. The predecessors of each activity and the duration of the activities are given. The number of compressors (consider it as a resource) required by each activity is also listed. The organization has only 6 compressors available with them. 1. Draw the schedule network diagram and determine the critical path. 2. Calculate the compressors needed on each day
