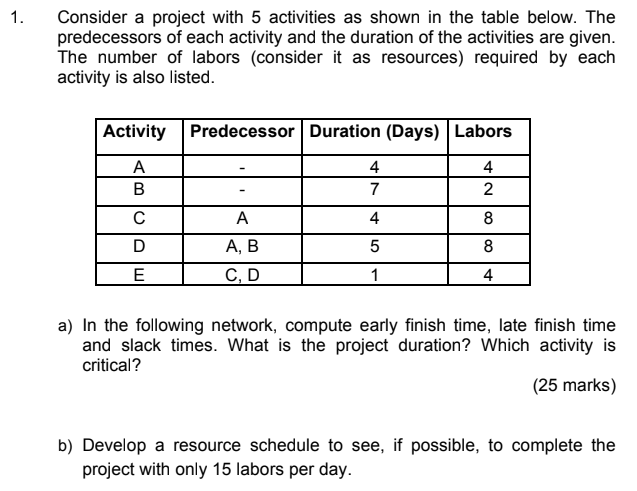

Question: Consider a project with 5 activities as shown in the table below. The predecessors of each activity and the duration of the activities are given.

Consider a project with 5 activities as shown in the table below. The predecessors of each activity and the duration of the activities are given. The number of labors (consider it as resources) required by each activity is also listed. a) In the following network, compute early finish time, late finish time and slack times. What is the project duration? Which activity is critical? (25 marks) b) Develop a resource schedule to see, if possible, to complete the project with only 15 labors per day
