Question: Advantage Energy Technology Data Center Migration (DCM) Given DCM story, the budget, and the schedule details below, follow the Risk Management Process steps outlined in

 Advantage Energy Technology Data Center Migration (DCM) Given DCM story, thebudget, and the schedule details below, follow the Risk Management Process stepsoutlined in Figure 7.2 Step 1: Identify a minimum of five risksto the DCM project. Step 2: Use the Impact Scale in Figure

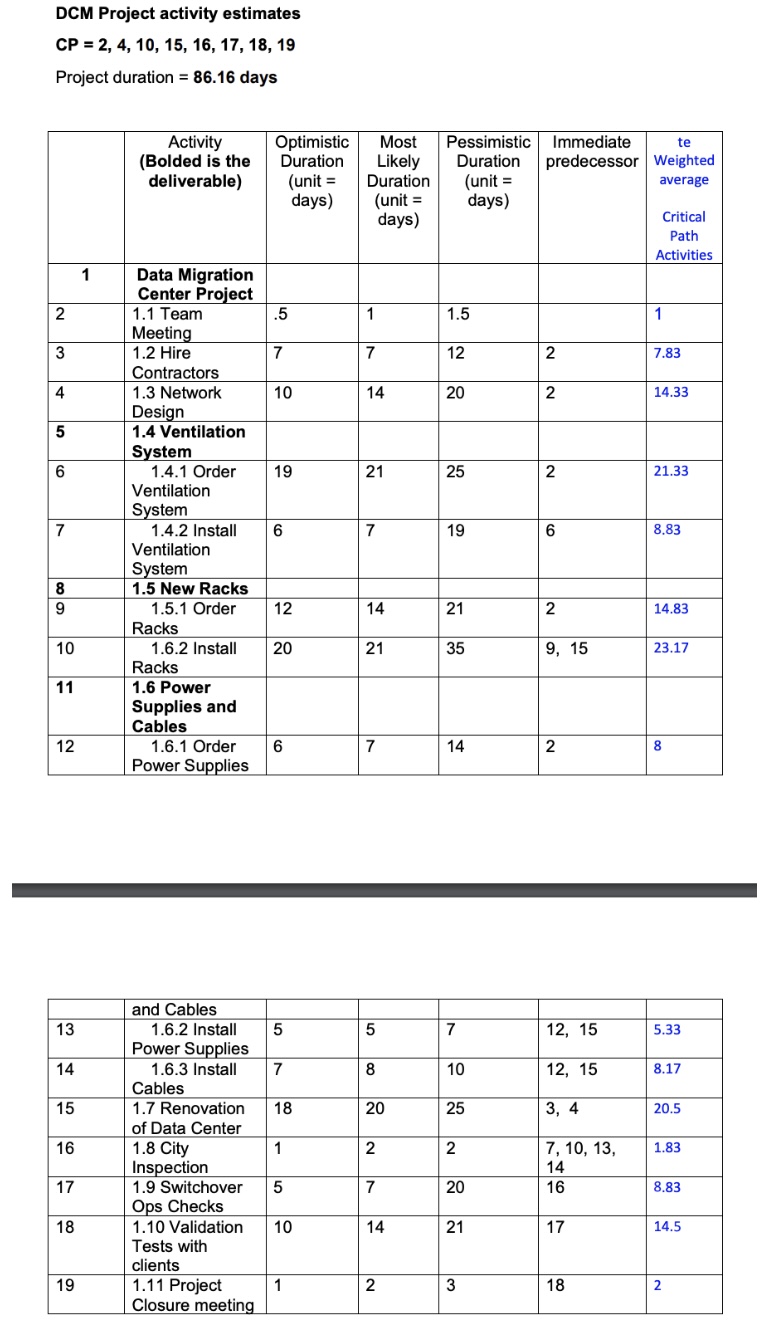

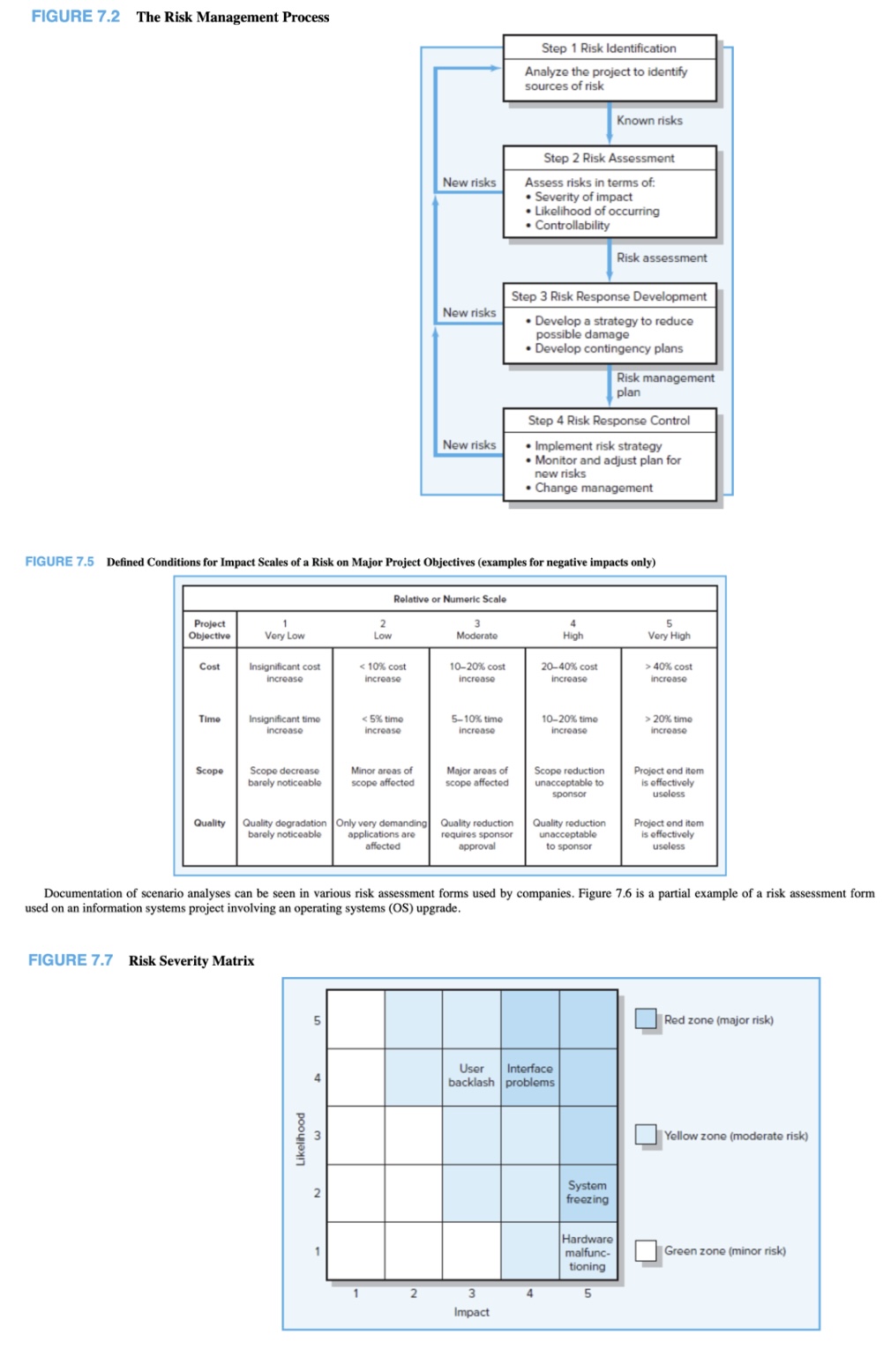

Advantage Energy Technology Data Center Migration (DCM) Given DCM story, the budget, and the schedule details below, follow the Risk Management Process steps outlined in Figure 7.2 Step 1: Identify a minimum of five risks to the DCM project. Step 2: Use the Impact Scale in Figure 7.5 (or create your own scale) and plot the risks on a Risk Severity Matrix (like Figure 7.7). Step 3: Develop a Risk Response Matrix (like Figure 7.8). Step 4: Create a simple Change Request Form (like Figure 7.10). DCM Project Budget... Total Budget =$85,000 Initial design Work =10% Ventilation System =35%( Parts =20%; labor =15%) New Racks =20%( Parts =15%; labor =5%) Power Supplies and Cables =25%( Parts =15%; labor =10%) Switchover Ops Checks =10% FIGURE 7.10 Sample Change Request Description of requested change 1. Request river dancers to replace small lrish dance group. 2. Request one combination dance with river dancers and China ballet group. Reason for change River dancers will enhance stature of event. The group is well known and loved by Chinese people. Areas of impact of proposed change-describe each on separate sheet [X] Scope [X] Cost Other Schedule Risk DCM Project activity estimates CP=2,4,10,15,16,17,18,19Projectduration=86.16days FIGURE 7.5 Defined Conditions for Impact Scales of a Risk on Major Project Objectives (examples for negative impacts only) Documentation of scenario analyses can be seen in various risk assessment forms used by companies. Figure 7.6 is a partial example of a risk assessment form used on an information systems project involving an operating systems (OS) upgrade. Advantage Energy Technology Data Center Migration (DCM) Given DCM story, the budget, and the schedule details below, follow the Risk Management Process steps outlined in Figure 7.2 Step 1: Identify a minimum of five risks to the DCM project. Step 2: Use the Impact Scale in Figure 7.5 (or create your own scale) and plot the risks on a Risk Severity Matrix (like Figure 7.7). Step 3: Develop a Risk Response Matrix (like Figure 7.8). Step 4: Create a simple Change Request Form (like Figure 7.10). DCM Project Budget... Total Budget =$85,000 Initial design Work =10% Ventilation System =35%( Parts =20%; labor =15%) New Racks =20%( Parts =15%; labor =5%) Power Supplies and Cables =25%( Parts =15%; labor =10%) Switchover Ops Checks =10% FIGURE 7.10 Sample Change Request Description of requested change 1. Request river dancers to replace small lrish dance group. 2. Request one combination dance with river dancers and China ballet group. Reason for change River dancers will enhance stature of event. The group is well known and loved by Chinese people. Areas of impact of proposed change-describe each on separate sheet [X] Scope [X] Cost Other Schedule Risk DCM Project activity estimates CP=2,4,10,15,16,17,18,19Projectduration=86.16days FIGURE 7.5 Defined Conditions for Impact Scales of a Risk on Major Project Objectives (examples for negative impacts only) Documentation of scenario analyses can be seen in various risk assessment forms used by companies. Figure 7.6 is a partial example of a risk assessment form used on an information systems project involving an operating systems (OS) upgrade

Step by Step Solution

There are 3 Steps involved in it

1 Expert Approved Answer
Step: 1 Unlock blur-text-image
Question Has Been Solved by an Expert!

Get step-by-step solutions from verified subject matter experts

Step: 2 Unlock
Step: 3 Unlock

Students Have Also Explored These Related Finance Questions!
