Question: Assume the network and data given in the following table If the indirect costs for each project duration are Rs. 4,00,000 ( 18 weeks ),
Assume the network and data given in the following table

If the indirect costs for each project duration are Rs. 4,00,000 ( 18 weeks ), Rs. 3,50,000 ( 17 weeks ), Rs. 3,00,000 ( 16 weeks ), Rs. 2,50,000 ( 15 weeks ), Rs. 2,00,000 (14 weeks ) and Rs. 1,50,000 (13 weeks ), what is the total project cost for each duration ? Identify the minimum total project cost duration.

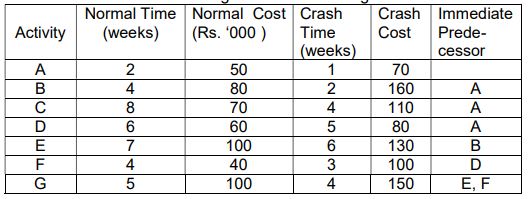

Activity Normal Time (weeks) B D E F G 2 4 8 6 7 4 5 Normal Cost Crash (Rs. '000) Time (weeks) 50 1 80 2 70 4 60 5 100 6 40 3 100 4 Crash Immediate Cost Prede- cessor 70 160 A 110 A . 80 A 130 B 100 D 150 E, FStep by Step Solution
There are 3 Steps involved in it
