Question: At a local university, the Student Commission on Programming and Entertainment (SCOPE) is preparing to host its first rock concert of the school year. To
At a local university, the Student Commission on Programming and Entertainment (SCOPE) is preparing to host its first rock concert of the school year. To successfully produce this rock concert, SCOPE has listed the requisite activities and related information in the following table (duration estimates measured in days).

Please help. Thank you

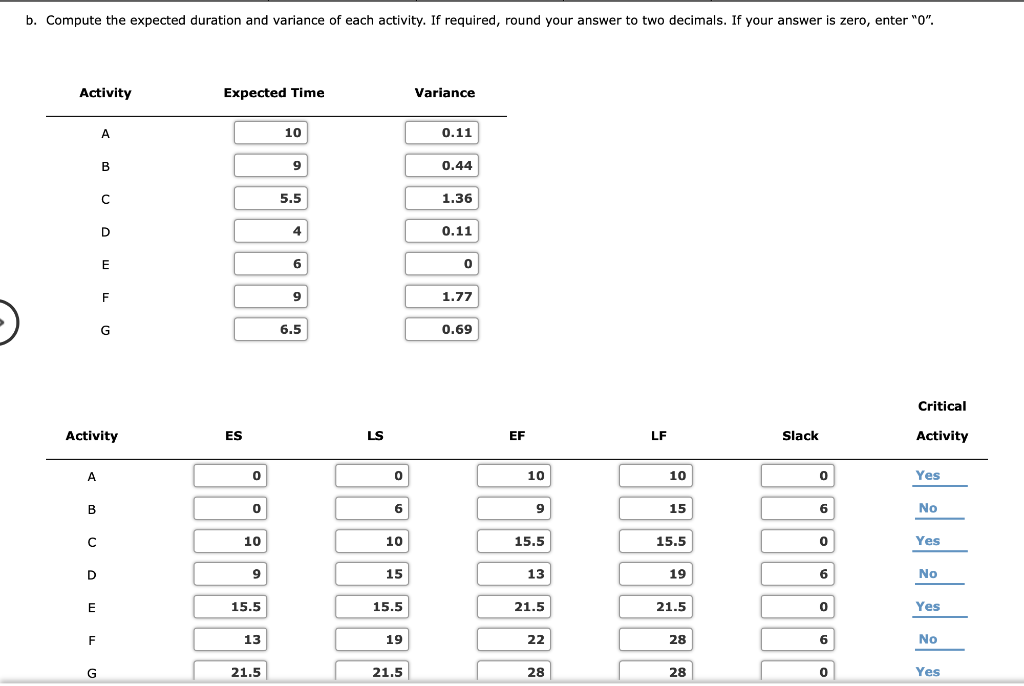

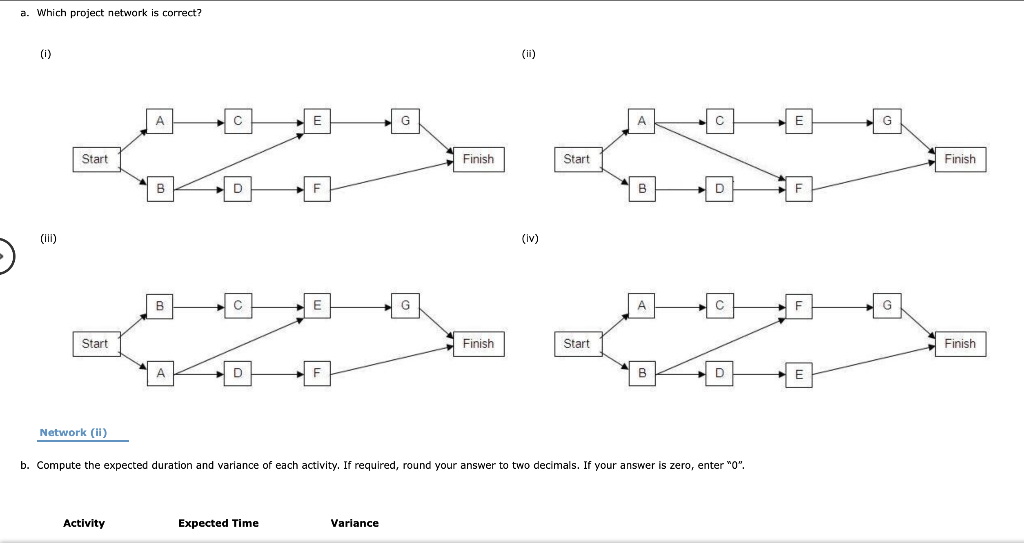

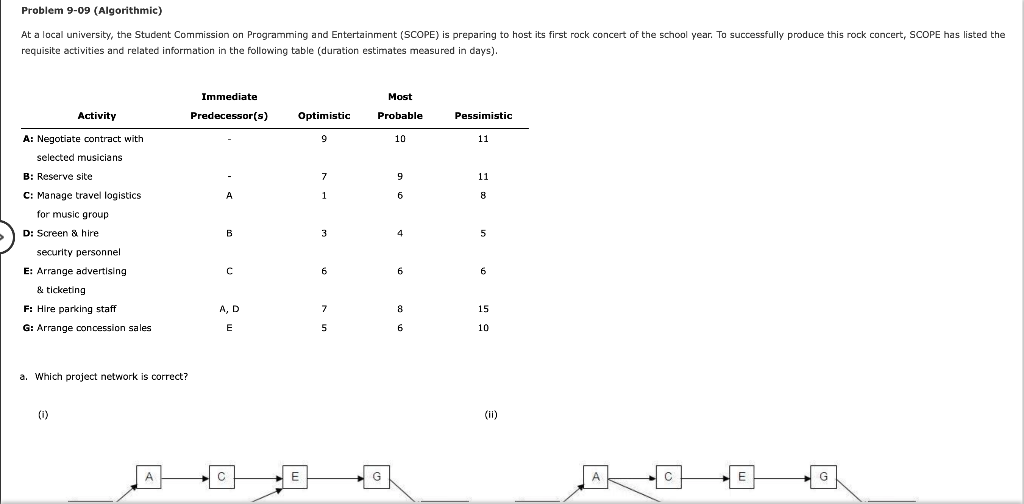

Problem 9-09 (Algorithmic) At a local university, the Student Commission on Programming and Entertainment (SCOPE) is preparing to host its first rock concert of the school year. To successfully produce this rock concert, SCOPE has listed the requisite activities and related information in the following table (duration estimates measured in days). Most Immediate Predecessor(s) Activity Optimistic Probable Pessimistic 9 10 11 11 A: Negotiate contract with selected musicians B: Reserve site C: Manage travel logistics for music group D: Screen & hire security personnel A 6 8 B 3 5 C 6 6 E: Arrange advertising & ticketing F: Hire parking staff G: Arrange concession sales 8 15 7 5 E 10 a. Which project network is correct? (i) (ii) A A G a. Which project network is correct? (0) (ii) G A G Start Finish Start Finish D B F (11) (iv) B G A F G Start Finish Start Finish A D B Network (ii) b. Compute the expected duration and variance of each activity. If required, round your answer to two decimals. If your answer is zero, enter "O". Activity Expected Time Variance b. Compute the expected duration and variance of each activity. If required, round your answer to two decimals. If your answer is zero, enter "0". Activity Expected Time Variance A 10 0.11 B 9 0.44 5.5 1.36 D 4 0.11 E 6 o F 9 1.77 G 6.5 0.69 Critical Activity ES LS EF LF Slack Activity A 0 0 10 10 0 Yes B 0 6 9 15 6 No 10 10 15.5 15.5 0 Yes D 9 15 13 19 6 No E 15.5 15.5 21.5 21.5 0 Yes F 13 19 22 28 6 6 No G 21.5 21.5 28 28 0 Yes EF Activity ES LS EF LF Slack Activity A 0 o 10 10 0 Yes B 0 9 15 6 No 10 10 15.5 15.5 0 Yes D 9 15 13 19 6 No E 15.5 15.5 21.5 21.5 0 Yes F 13 19 22 28 6 No G 21.5 21.5 28 28 0 0 Yes C. Determine the critical path in the project network. A-C-E-G d. What is the expected duration and variance of the critical path? If required, round your answer to two decimals. Expected duration = 28 Variance 2.16 e. What is the likelihood that the project will be completed within 30 days? If required, round your answer to four decimals. Note: Use Appendix B to identify the probability. Likelihood f. If activity B is delayed by six days beyond its early start time, how does this affect the expected project duration? If required, round your answer to one decimal place. A delay of 6 days to activity B will affect the time to complete this project because activity B has a slack of 6 days. g. Using all paths through the project network, estimate the probability that the project will be completed within 30 days. Compare your answer to the answer in parte and explain. Round your answers for z values to Determine the Chical path in the projea network. A-C-E-G d. What is the expected duration and variance of the critical path? If required, round your answer to two decimals. Expected duration = 28 Variance = 2.16 e. What is the likelihood that the project will be completed within 30 days? If required, round your answer four decimals. Note: Use Appendix B to identify the probability Likelihood = f. If activity B is delayed by six days beyond its early start time, how does this affect the expected project duration? If required, round your answer to one decimal place. A delay of 6 days to activity B will affect the time to complete this project because activity B has a slack of 6 days. 9. Using all paths through the project network, estimate the probability that the project will be completed within 30 days. Compare your answer to the answer in part e and explain. Round your answers for z values to 2 decimal places and for probability values to 4 decimal places. For path B-D-F: Cumulative probability For path A-F: Cumulative probability = P(cutire project completed) =Step by Step Solution
There are 3 Steps involved in it
Get step-by-step solutions from verified subject matter experts
