Question: Consider that the maximum resource hours available per week are 15, determine which weeks are overcommitted. For ES , EF, LS, LF refer to table


Consider that the maximum resource hours available per week are 15, determine which weeks are overcommitted.

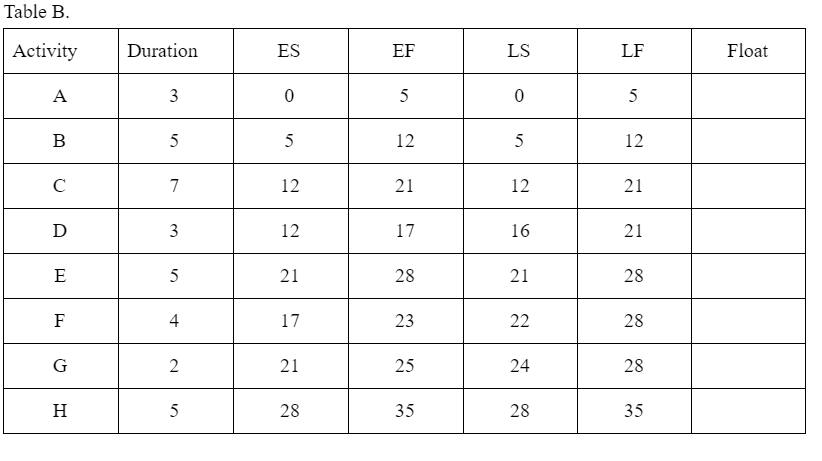

For ES , EF, LS, LF refer to table B

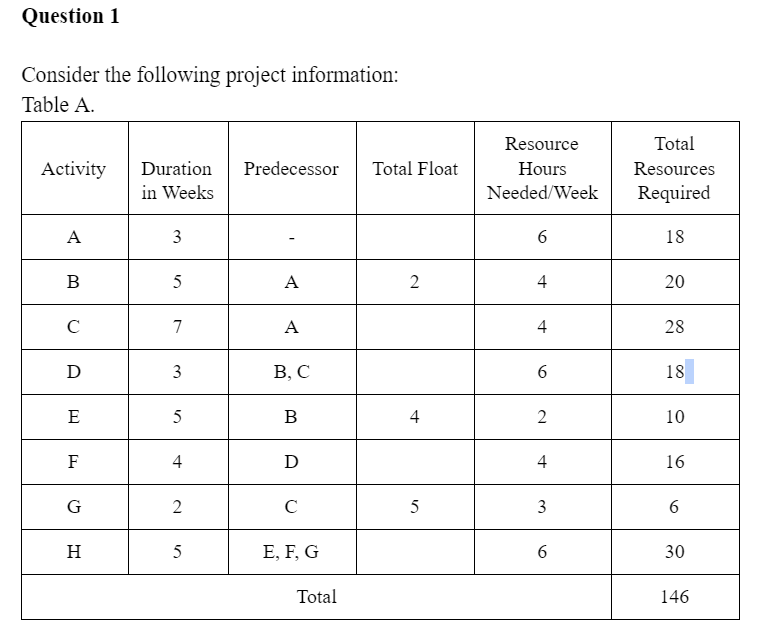

Question 1 Consider the following project information: Table A. Activity Predecessor Total Float Duration in Weeks Resource Hours Needed/Week Total Resources Required A 3 6 18 B 5 A 2 4 20 7 A 4 28 D 3 3 B, C 6 18 E 5 B 4 2 10 F 4 D 4 16 2 5 3 6 H 5 E, F, G 6 30 Total 146 Question 1 Consider the following project information: Table A. Activity Predecessor Total Float Duration in Weeks Resource Hours Needed/Week Total Resources Required A 3 6 18 B 5 A 2 4 20 7 A 4 28 D 3 3 B, C 6 18 E 5 B 4 2 10 F 4 D 4 16 2 5 3 6 H 5 E, F, G 6 30 Total 146Step by Step Solution
