Question: Consider the project network given below: The data for normal times, crash times, and crashing costs are given as follows: Let ( T

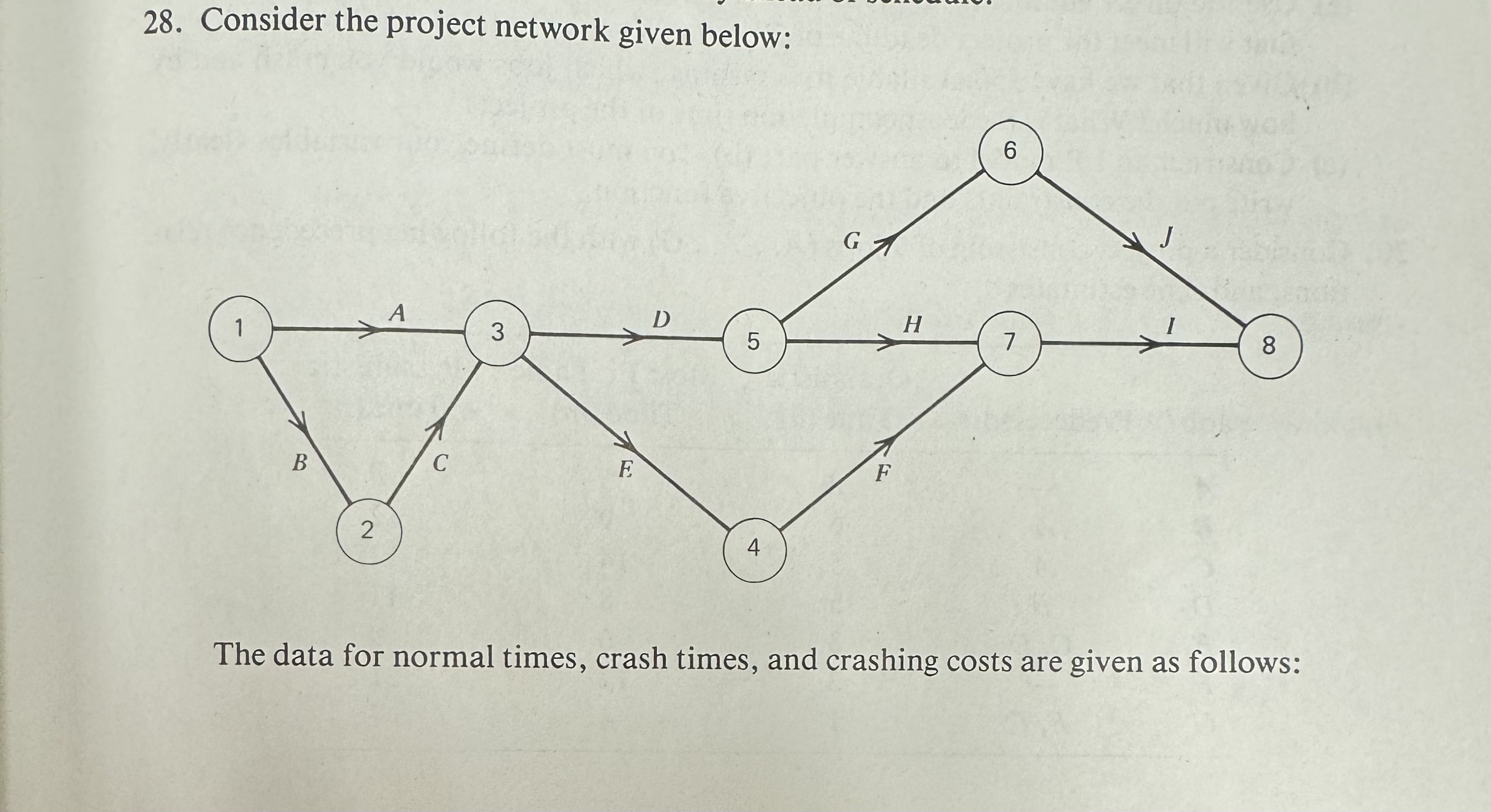

Consider the project network given below:
The data for normal times, crash times, and crashing costs are given as follows:
Let \( T \) represent the earliest completion time of the project.
(a), Determine the maximum and the minimum value of \( T \).
(b) Set up the linear program to solve the CPM problem if the project is to be completed in 21 days at minimum cost.
(c) Given the overhead costs as \(\$ 5\) per day, determine the optimal duration of the project in terms of both the crashing and the overhead costs by direct enumeration method.
 Consider the project network given below: The data for normal times,

Step by Step Solution

There are 3 Steps involved in it

1 Expert Approved Answer
Step: 1 Unlock blur-text-image
Question Has Been Solved by an Expert!

Get step-by-step solutions from verified subject matter experts

Step: 2 Unlock
Step: 3 Unlock

Students Have Also Explored These Related General Management Questions!
