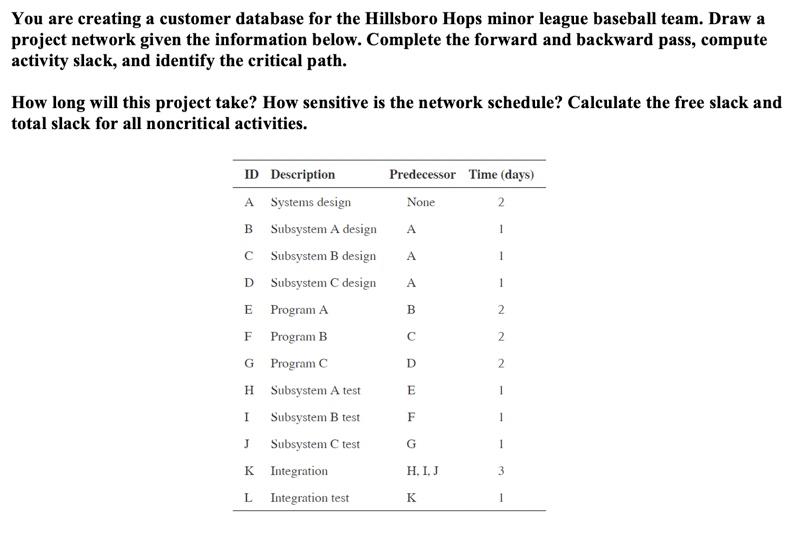

Question: Draw a project network given the information below. Complete the forward and backward pass, compute activity slack, and identify the critical path. How long will

- Draw a project network given the information below.
- Complete the forward and backward pass, compute activity slack, and identify the critical path.
- How long will this project take? How sensitive is the network schedule?
- Calculate the free slack and total slack for all noncritical activities.
