Question: Draw the updated network. Calculate the new project completion date, Check if there are changes to the completion date and / or to the critical

Draw the updated network. Calculate the new project completion date, Check if there are changes to the completion date and/or to the critical path,

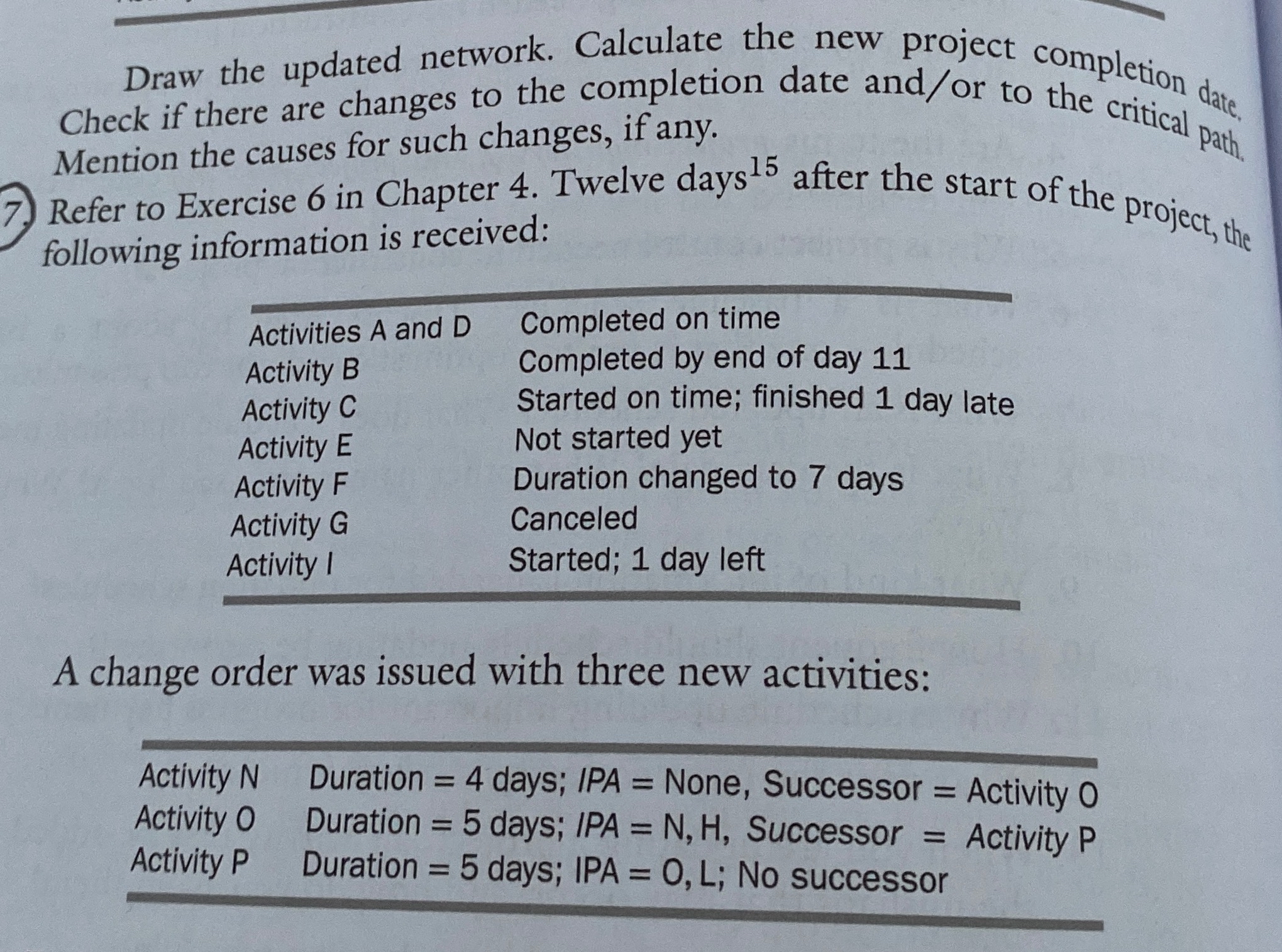

7. Refer to Exercise 6 in Chapter 4. Twelve days ?15 after the start of the project, the following information is received:
\table[[Activities A and D,Completed on time],[Activity B,Completed by end of day 11],[Activity C,Started on time; finished 1 day late],[Activity E,Not started yet],[Activity F,Duration changed to 7 days],[Activity G,Canceled],[Activity I,Started; 1 day left]]
A change order was issued with three new activities:
\table[[Activity N,Duration =4 days; IPA = None, Successor = Activity O
 Draw the updated network. Calculate the new project completion date, Check

Step by Step Solution

There are 3 Steps involved in it

1 Expert Approved Answer
Step: 1 Unlock blur-text-image
Question Has Been Solved by an Expert!

Get step-by-step solutions from verified subject matter experts

Step: 2 Unlock
Step: 3 Unlock

Students Have Also Explored These Related General Management Questions!
