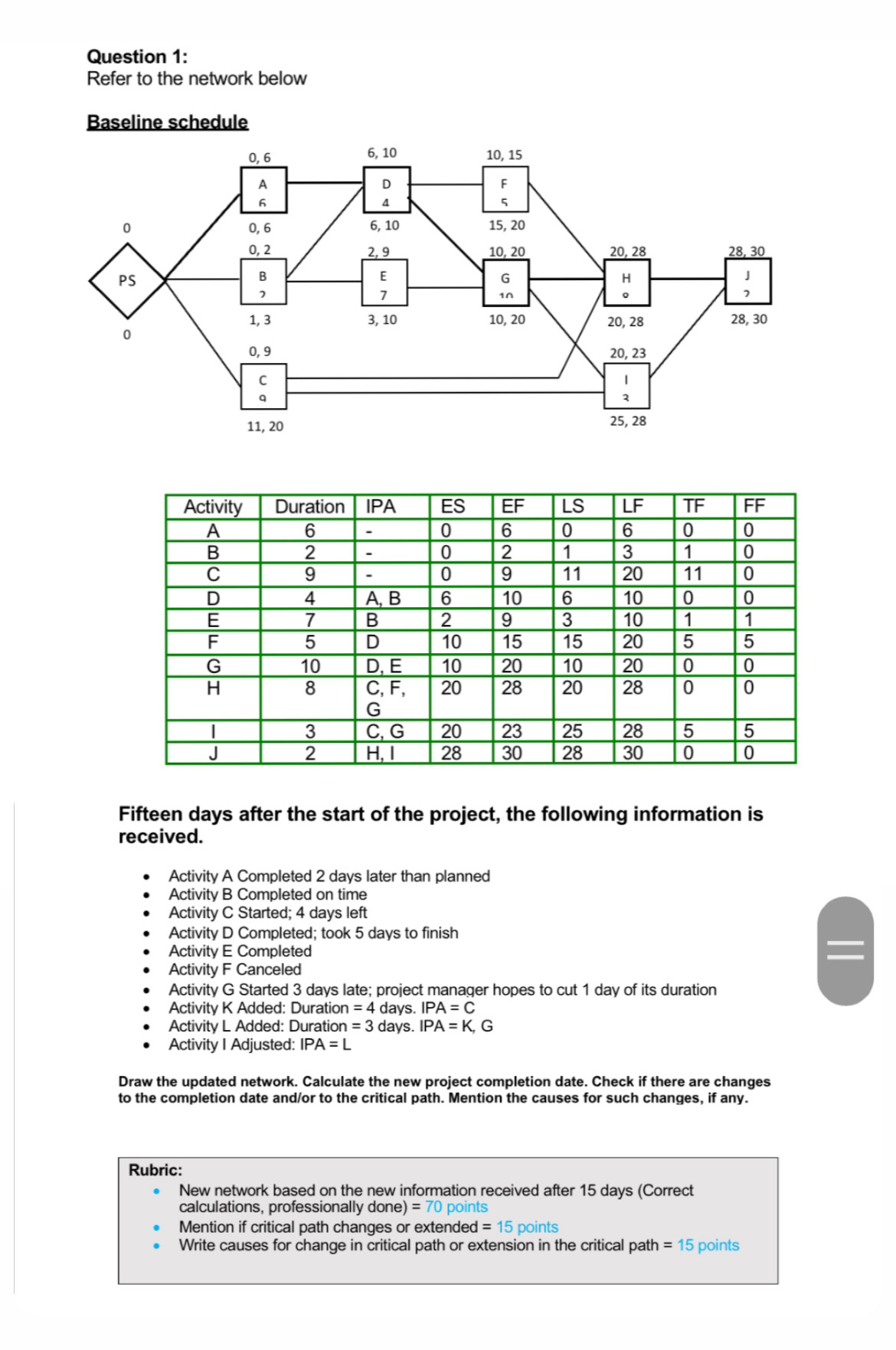

Question: Question 1 : Refer to the network below Baseline schedule table [ [ Activity , Duration,IPA,ES , EF , LS , LF , TF

Question 1:
Refer to the network below
Baseline schedule
\table[[Activity,Duration,IPA,ES,EF,LS,LF,TF,FF],[A,6,-,0,6,0,6,0,0],[B,2,-,0,2,1,3,1,0],[C,9,-,0,9,11,20,11,0],[D,4,A, B,6,10,6,10,0,0],[E,7,B,2,9,3,10,1,1],[F,5,D,10,15,15,20,5,5],[G,10,D, E,10,20,10,20,0,0],[H,8,C, F,,20,28,20,28,0,0],[I,3,C, G,20,23,25,28,5,5],[J,2,H, I,28,30,28,30,0,0]]
Fifteen days after the start of the project, the following information is received.
Activity A Completed 2 days later than planned
Activity B Completed on time
Activity C Started; 4 days left
Activity D Completed; took 5 days to finish
Activity E Completed
Activity F Canceled
Activity G Started 3 days late; project manager hopes to cut 1 day of its duration
Activity K Added: Duration =4 days. IPA =C
Activity L Added: Duration =3 days. IPA =K,G
Activity I Adjusted: IPA = L
Draw the updated network. Calculate the new project completion date. Check if there are changes to the completion date and/or to the critical path. Mention the causes for such changes, if any.
Rubric:
New network based on the new information received after 15 days (Correct calculations, professionally done)=70 points
Mention if critical path changes or extended =15 points
Write causes for change in critical path or extension in the critical path =15 points
 Question 1: Refer to the network below Baseline schedule \table[[Activity,Duration,IPA,ES,EF,LS,LF,TF,FF],[A,6,-,0,6,0,6,0,0],[B,2,-,0,2,1,3,1,0],[C,9,-,0,9,11,20,11,0],[D,4,A, B,6,10,6,10,0,0],[E,7,B,2,9,3,10,1,1],[F,5,D,10,15,15,20,5,5],[G,10,D,

Step by Step Solution

There are 3 Steps involved in it

1 Expert Approved Answer
Step: 1 Unlock blur-text-image
Question Has Been Solved by an Expert!

Get step-by-step solutions from verified subject matter experts

Step: 2 Unlock
Step: 3 Unlock

Students Have Also Explored These Related General Management Questions!
