Question: From question d) answer, i wonder why they crash only activity E instead of crash both E and B because in the question it asks

From question d) answer, i wonder why they crash only activity E instead of crash both E and B because in the question it asks the maximum time that can be crashed. so, if i crash both E and B the project duration will be 6 instead of 7 and i feel this is the right maximum time can be crashed. If it about price, when crashing ADG, why they crash activity A which has the same crash cost as B.From question d) answer, i wonder why they crash

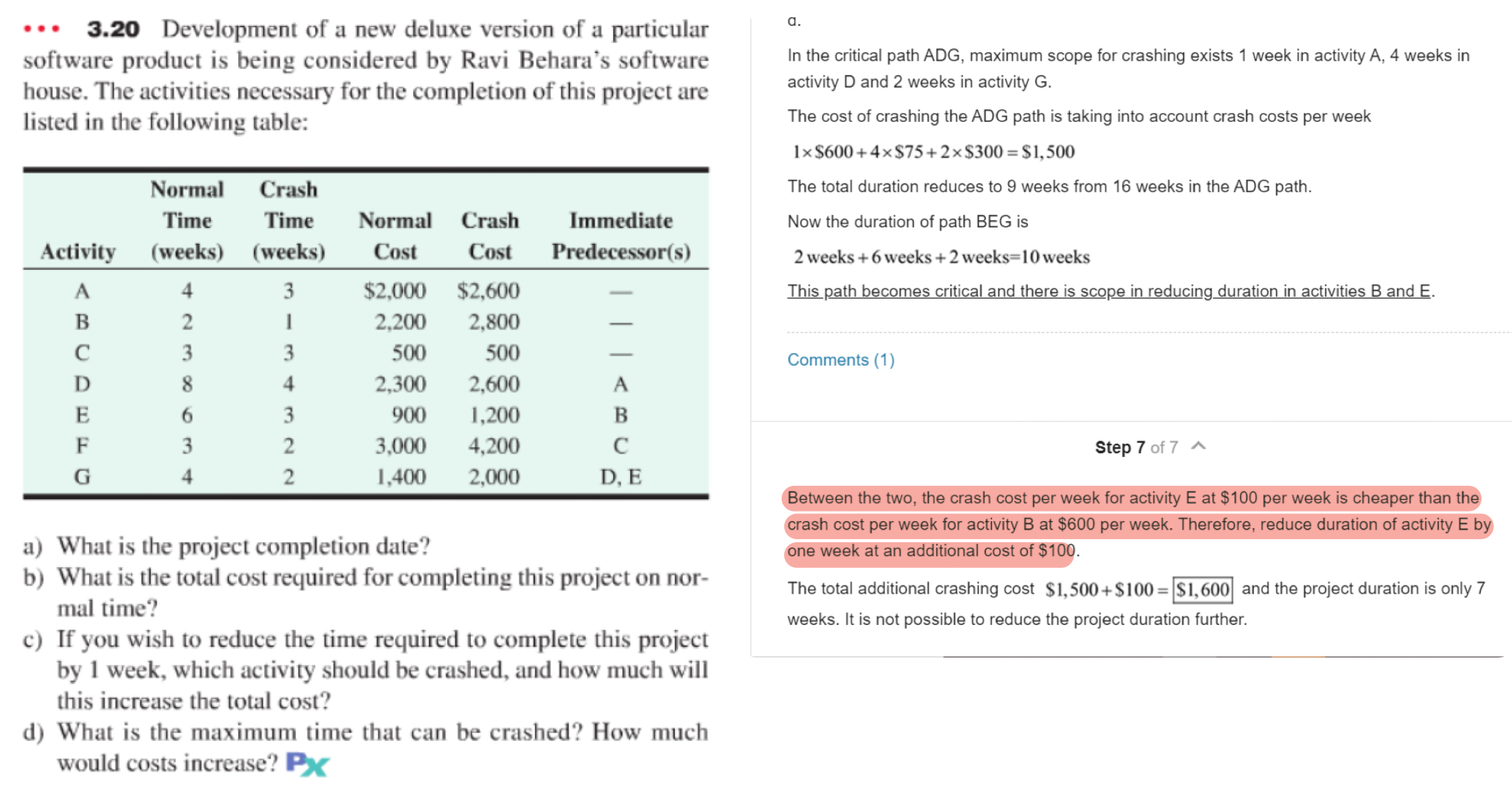

... 3.20 Development of a new deluxe version of a particular software product is being considered by Ravi Behara's software house. The activities necessary for the completion of this project are listed in the following table: In the critical path ADG, maximum scope for crashing exists 1 week in activity A, 4 weeks in activity D and 2 weeks in activity G. The cost of crashing the ADG path is taking into account crash costs per week 1x $600+ 4x $75+2 x $300 = $1,500 The total duration reduces to 9 weeks from 16 weeks in the ADG path. Normal Time (weeks) Crash Time (weeks) Now the duration of path BEG is Immediate Predecessor(s) Activity 2 weeks + 6 weeks + 2 weeks=10 weeks This path becomes critical and there is scope in reducing duration in activities B and E. 3 3 Normal Crash Cost Cost $2,000 $2,600 2,200 2,800 500 500 2,300 2,600 900 1,200 3,000 4,200 1,400 2,000 Comments (1) Step 7 of 7 A Between the two, the crash cost per week for activity E at $100 per week is cheaper than the crash cost per week for activity B at $600 per week. Therefore, reduce duration of activity E by one week at an additional cost of $100. The total additional crashing cost $1,500+$100 = $1,600) and the project duration is only 7 weeks. It is not possible to reduce the project duration further. a) What is the project completion date? b) What is the total cost required for completing this project on nor- mal time? c) If you wish to reduce the time required to complete this project by 1 week, which activity should be crashed, and how much will this increase the total cost? d) What is the maximum time that can be crashed? How much would costs increase? Px

Step by Step Solution

There are 3 Steps involved in it

1 Expert Approved Answer
Step: 1 Unlock blur-text-image
Question Has Been Solved by an Expert!

Get step-by-step solutions from verified subject matter experts

Step: 2 Unlock
Step: 3 Unlock

Students Have Also Explored These Related General Management Questions!
